C|24 (Curtis) Forensic Report
I. Project Summary
- Role: Mechanical Engineering Lead / Industrial Design Lead.
- Mandate: Execute a total platform modernization (“RoHS/Refresh”) of the legacy Control|24 console: eliminate a ~$200/unit licensing royalty by moving to 16 in-house pre-amps, integrate 5.1 surround monitoring, cut the form factor to 43 inches, and hold the $9,995 MSRP under the new EU compliance regime.
- Core Achievement: Delivered 500 units for Q4 2007 FQA/revenue recognition despite a dual-front supply chain collapse, a thermal yield crisis during Pilot, and regulatory certification bottlenecks.
II. The Anatomy of Failure

1. Thermal Crisis: The “Banana” Defect

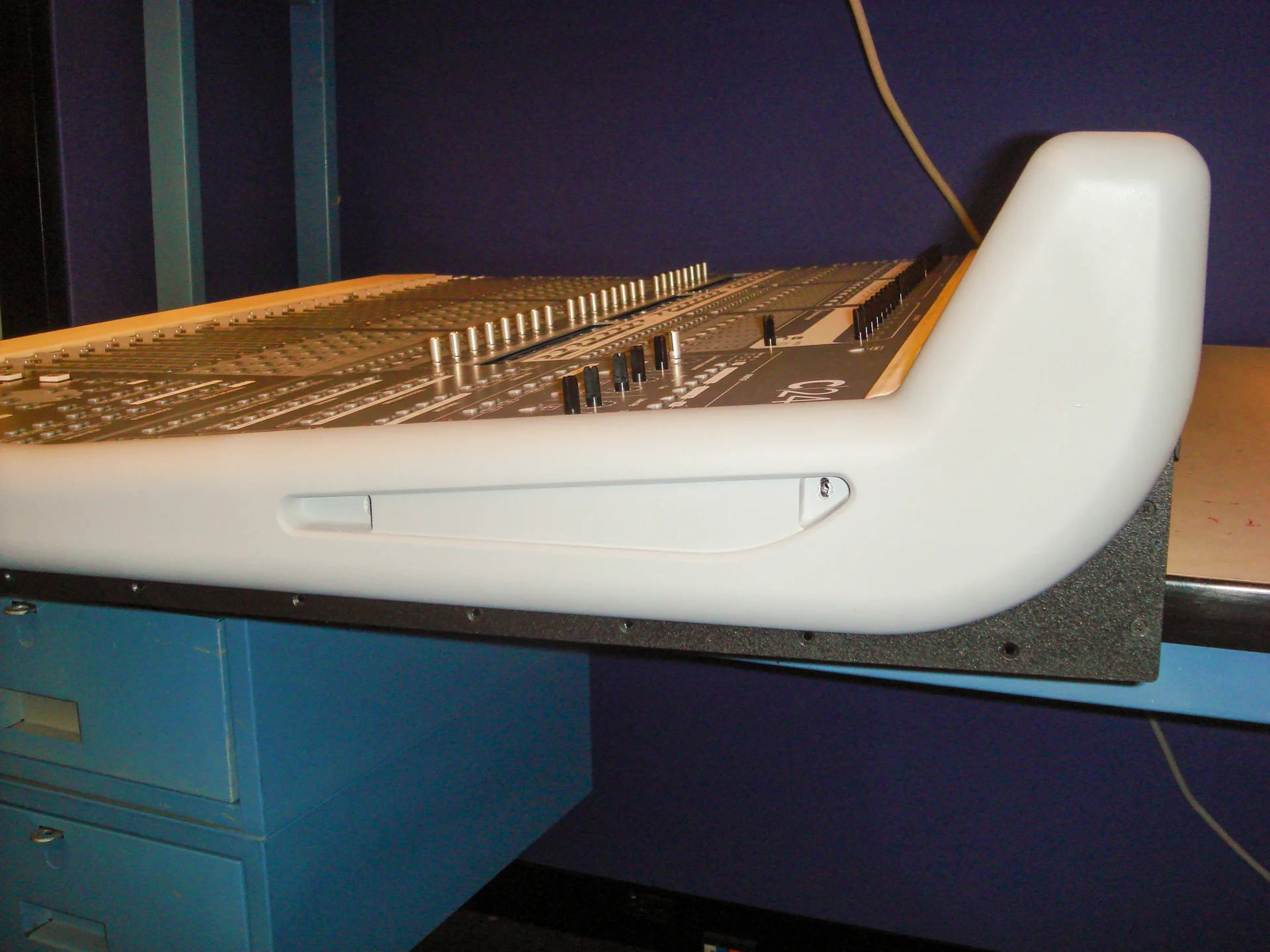

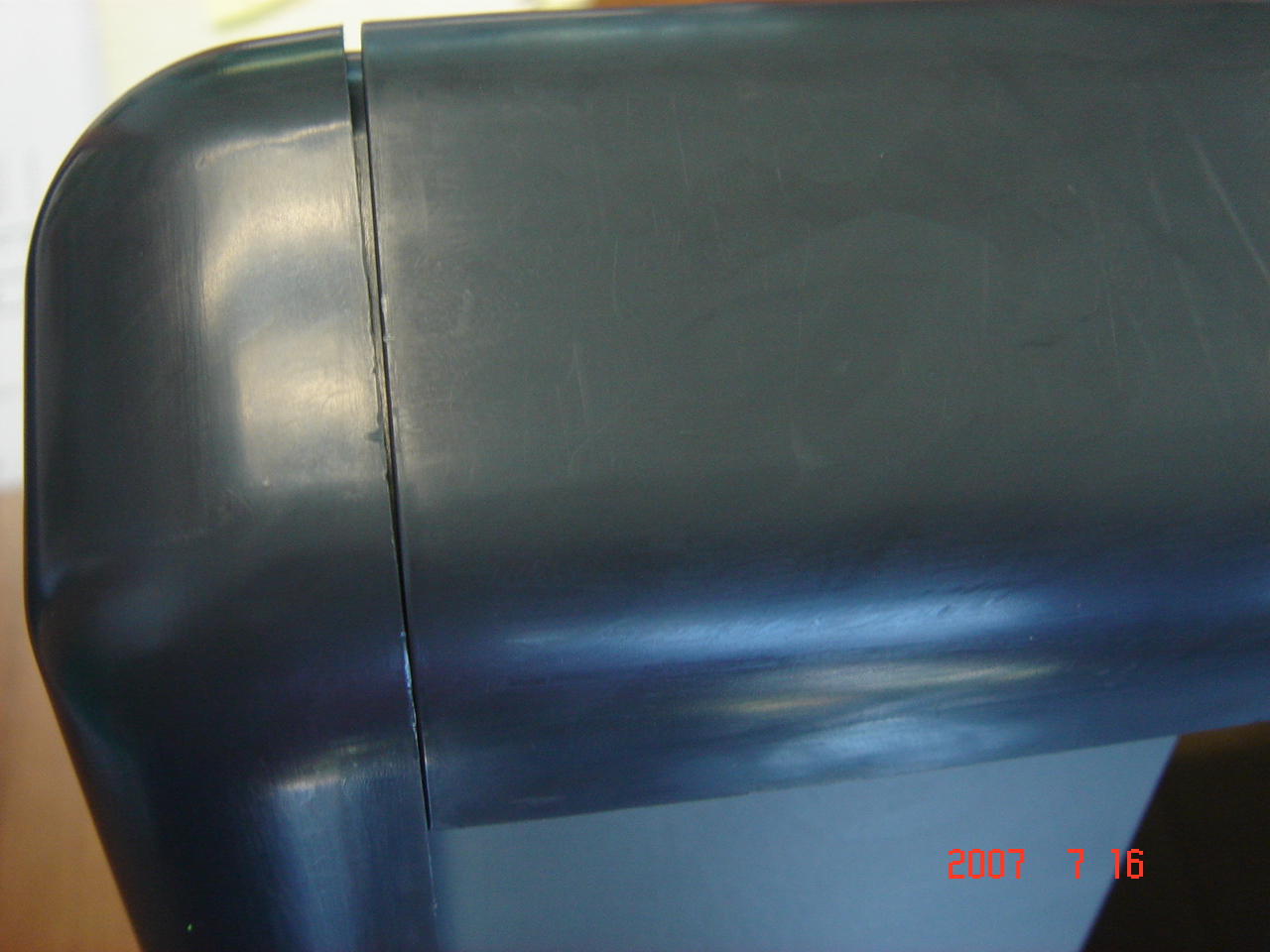

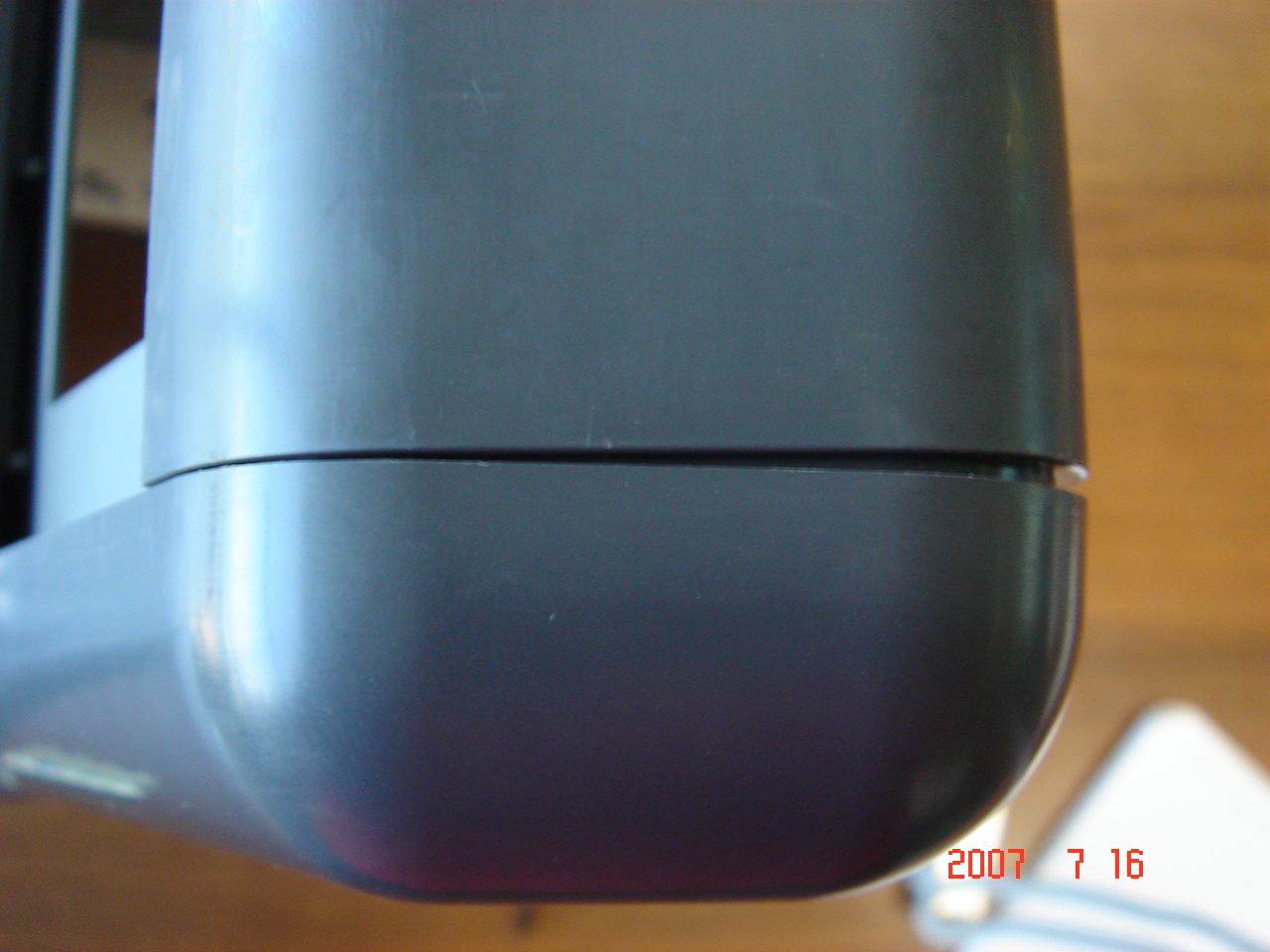

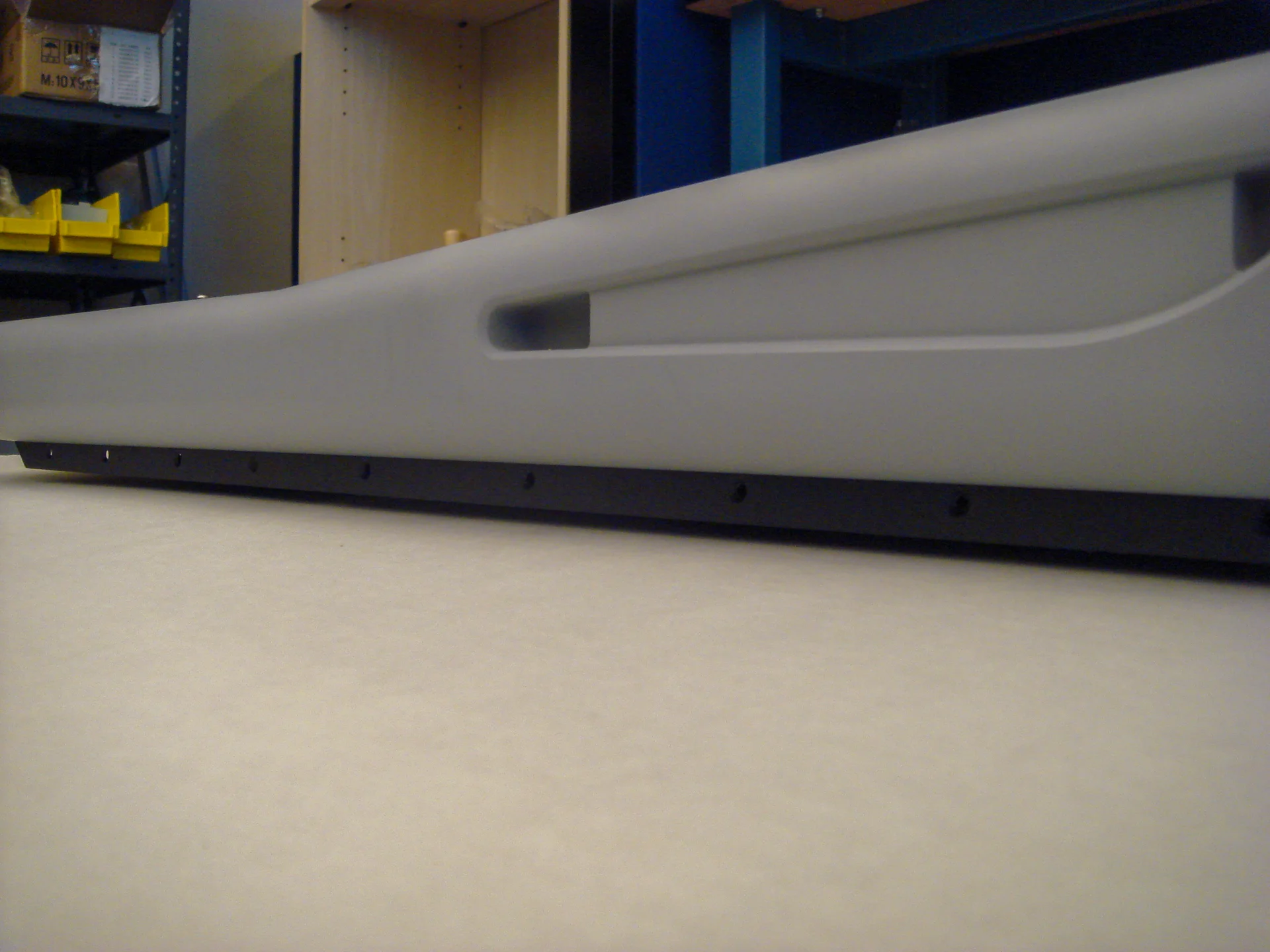

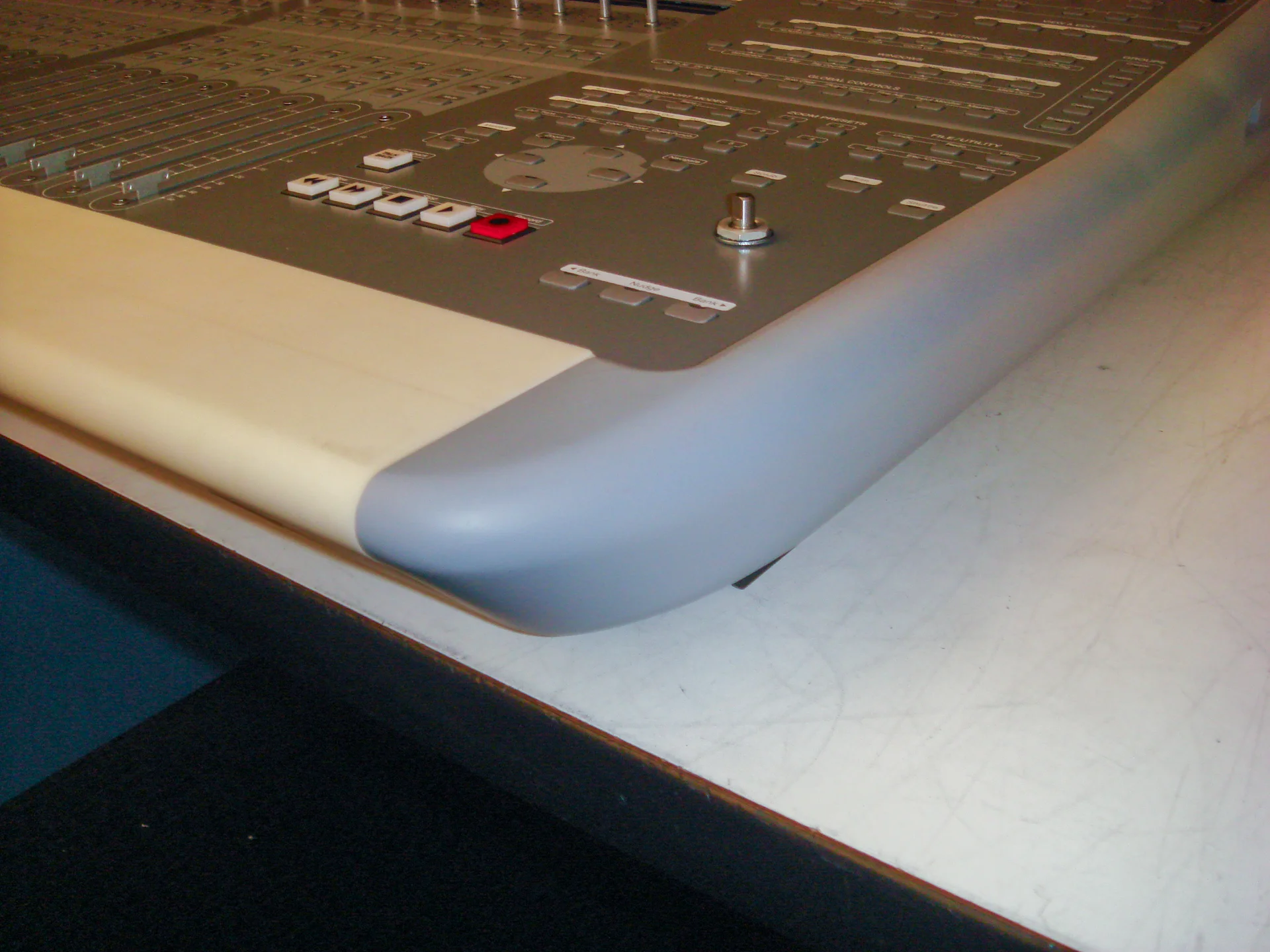

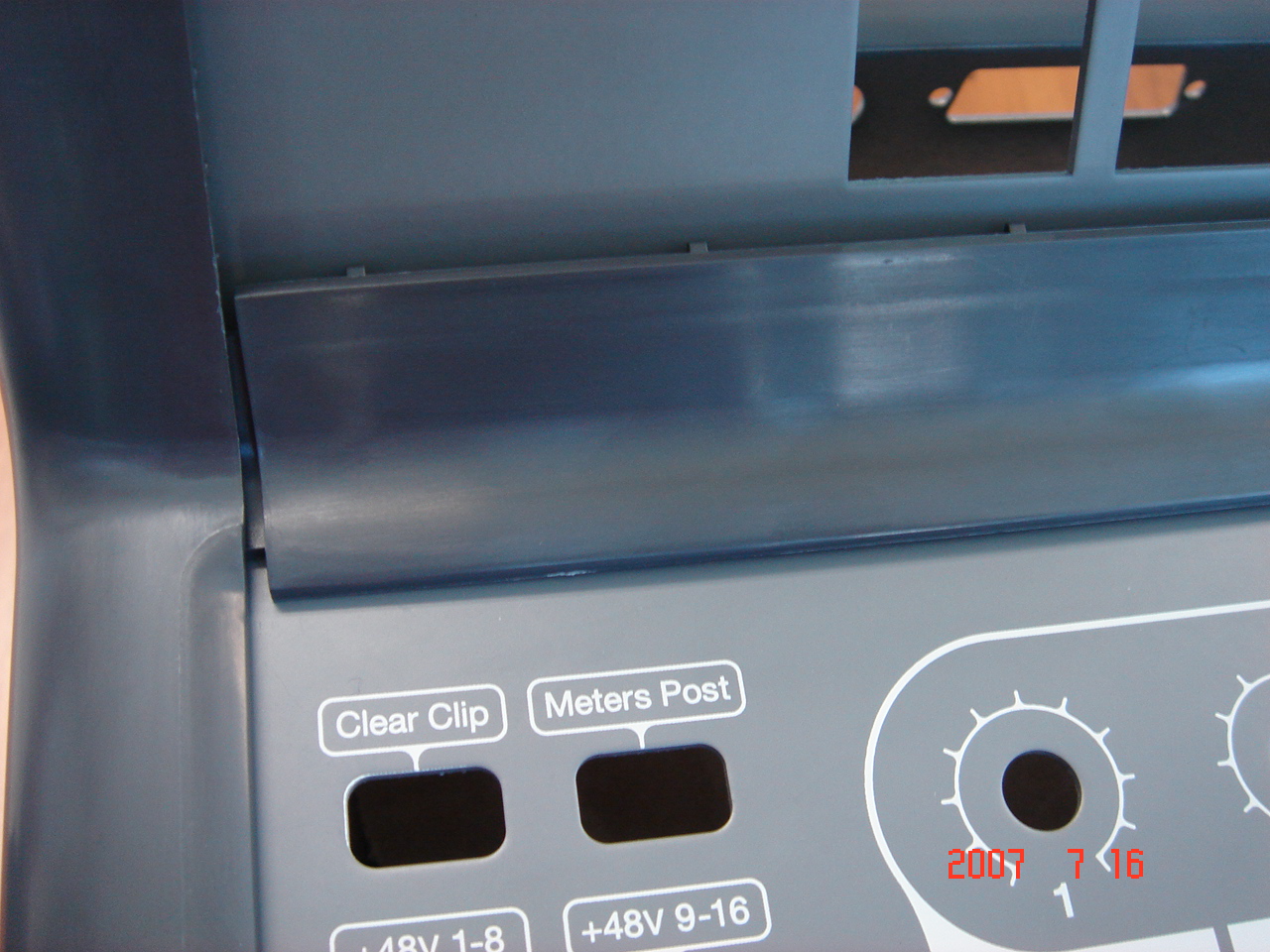

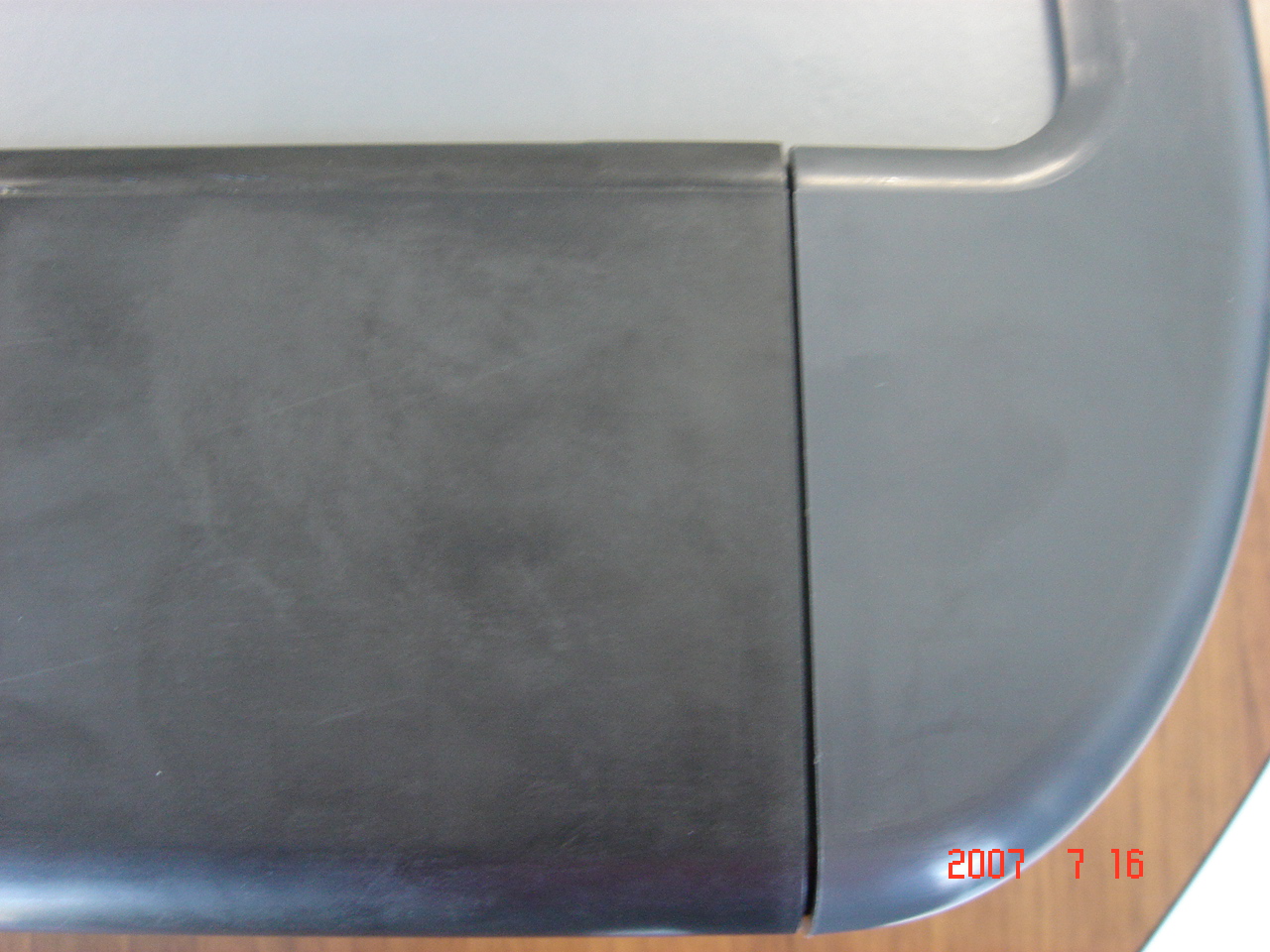

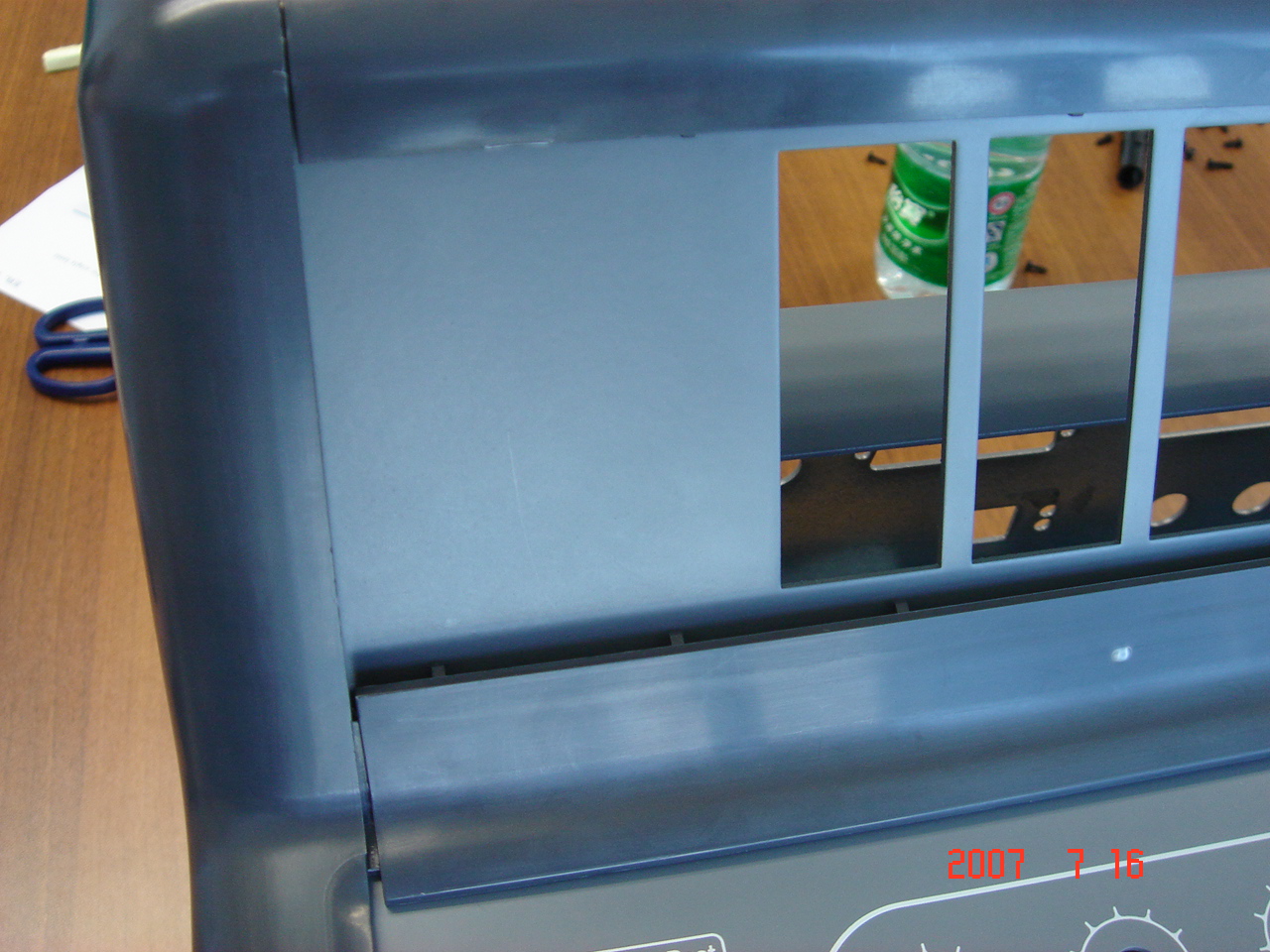

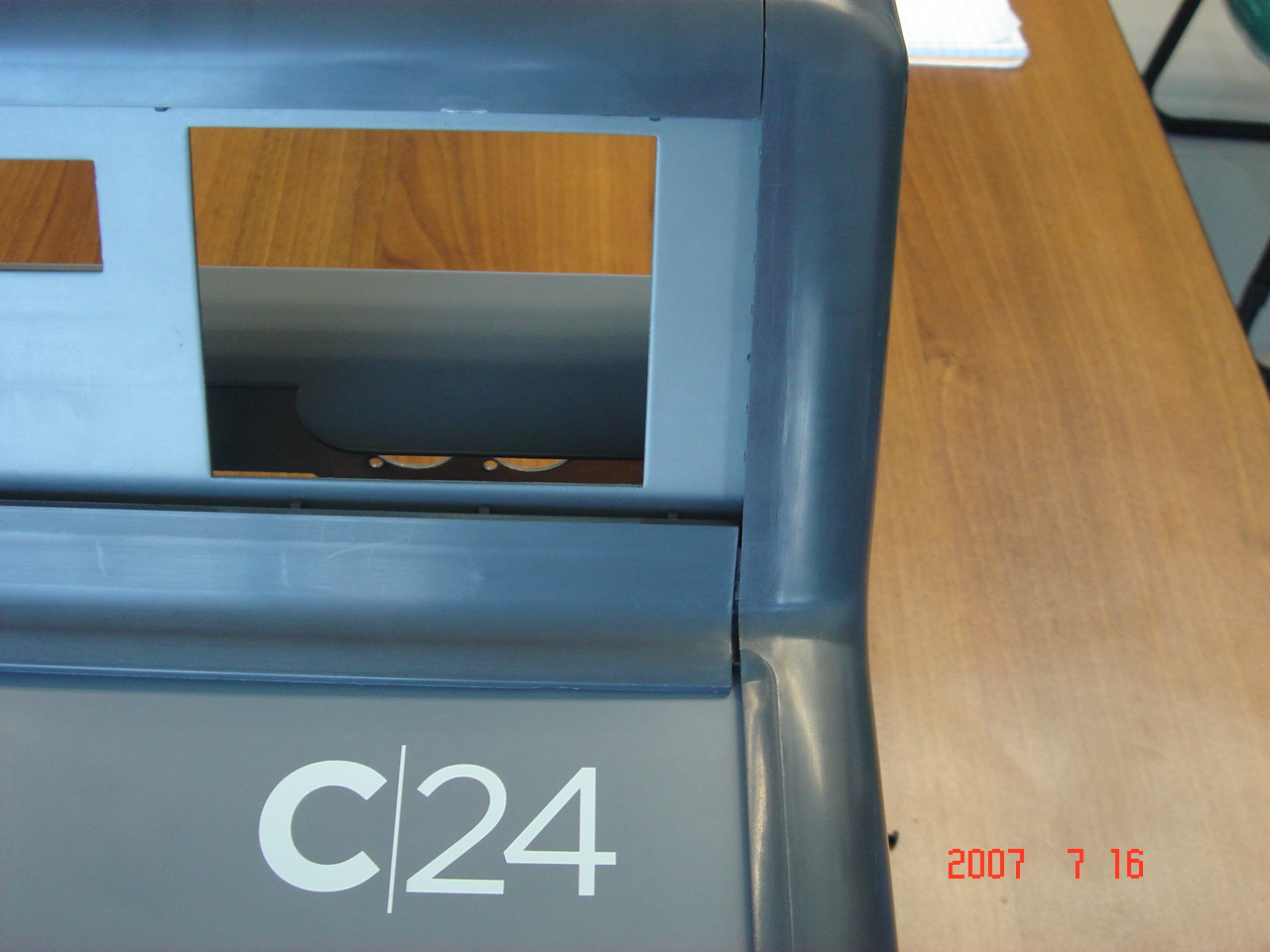

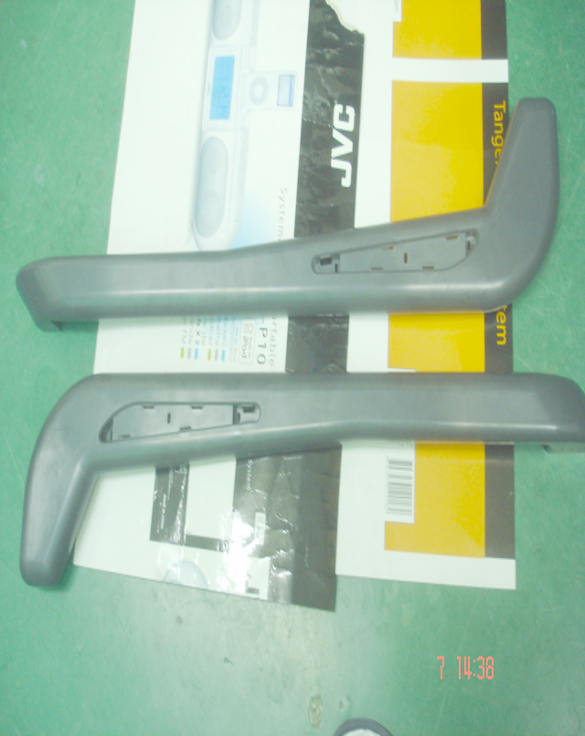

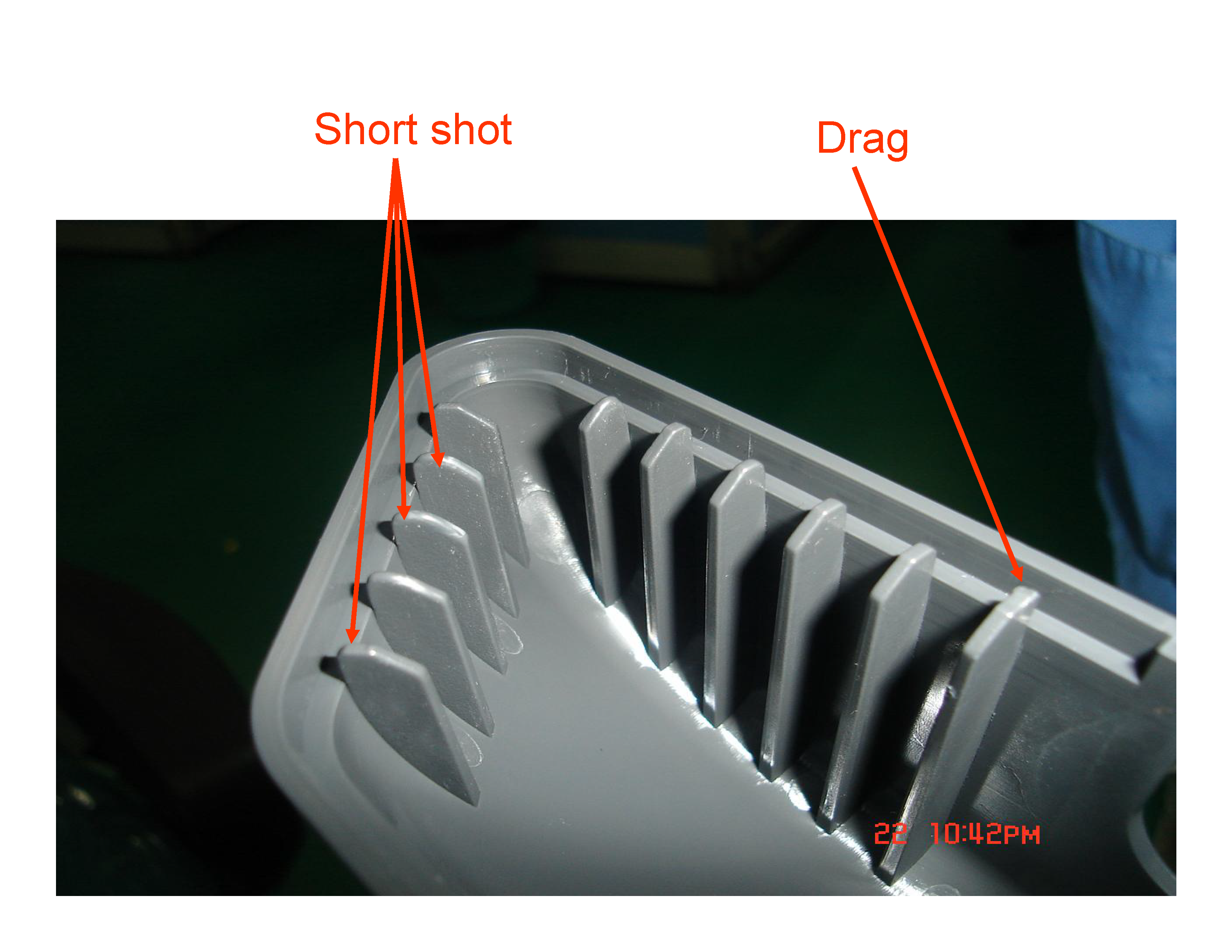

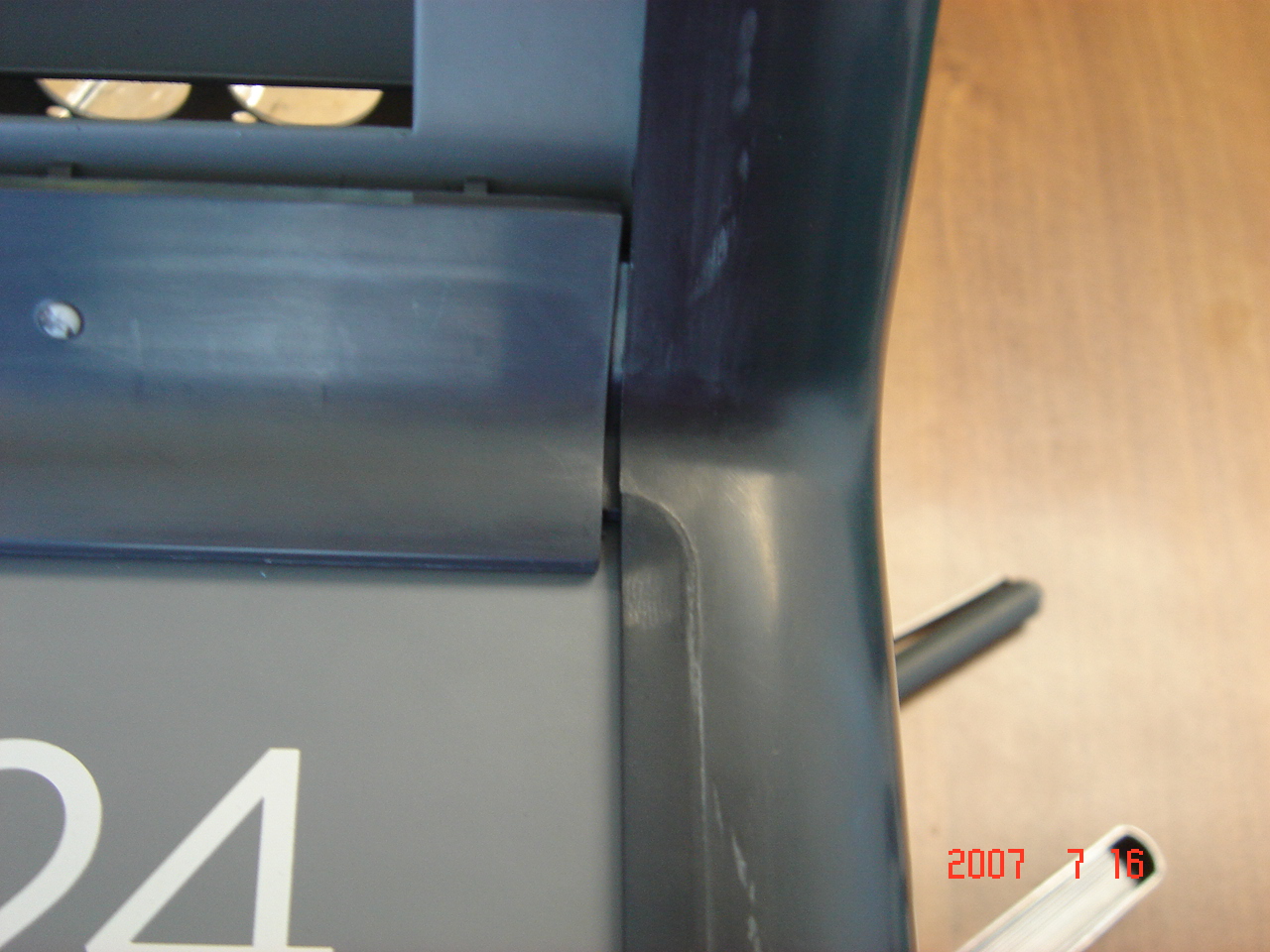

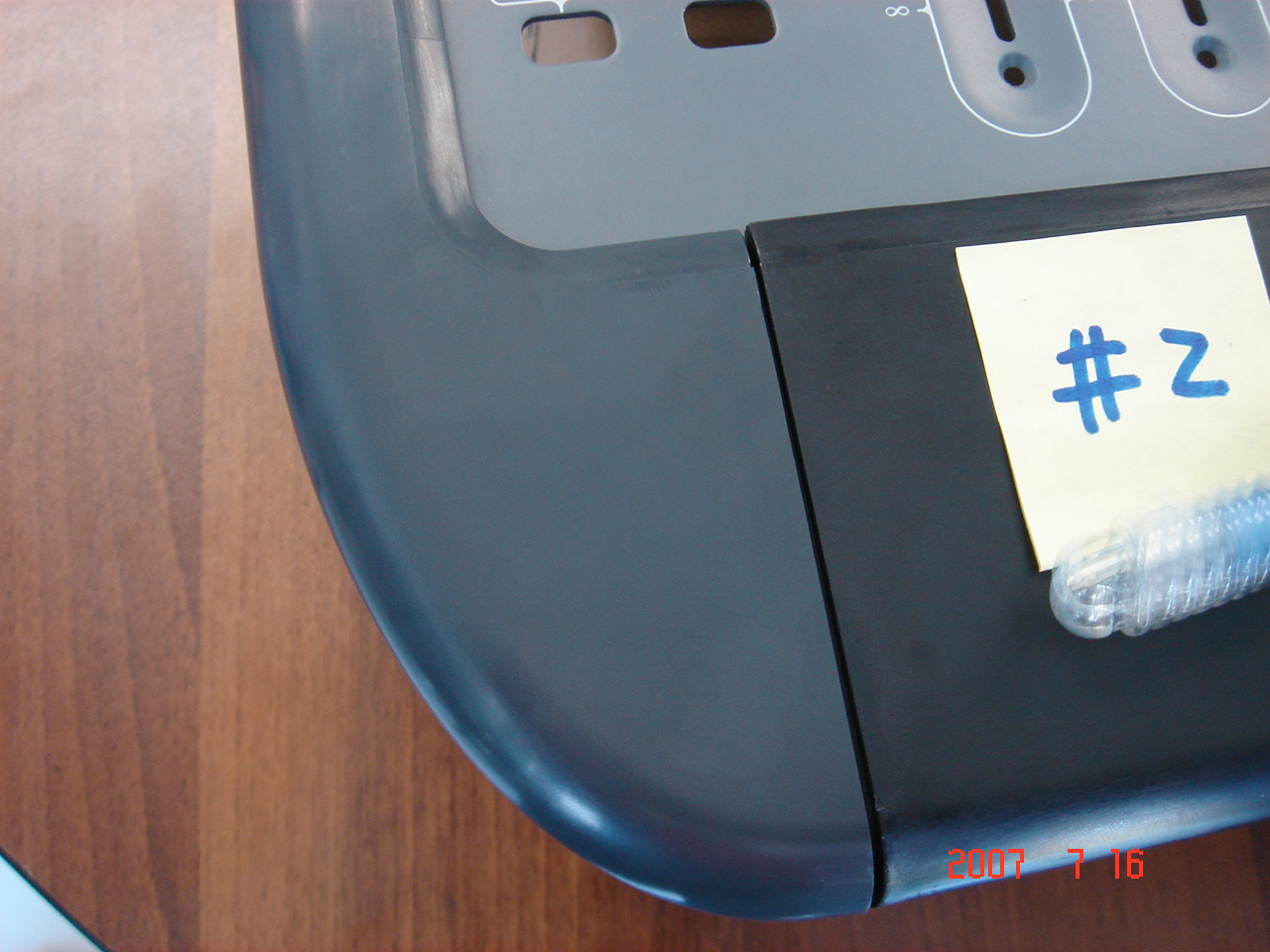

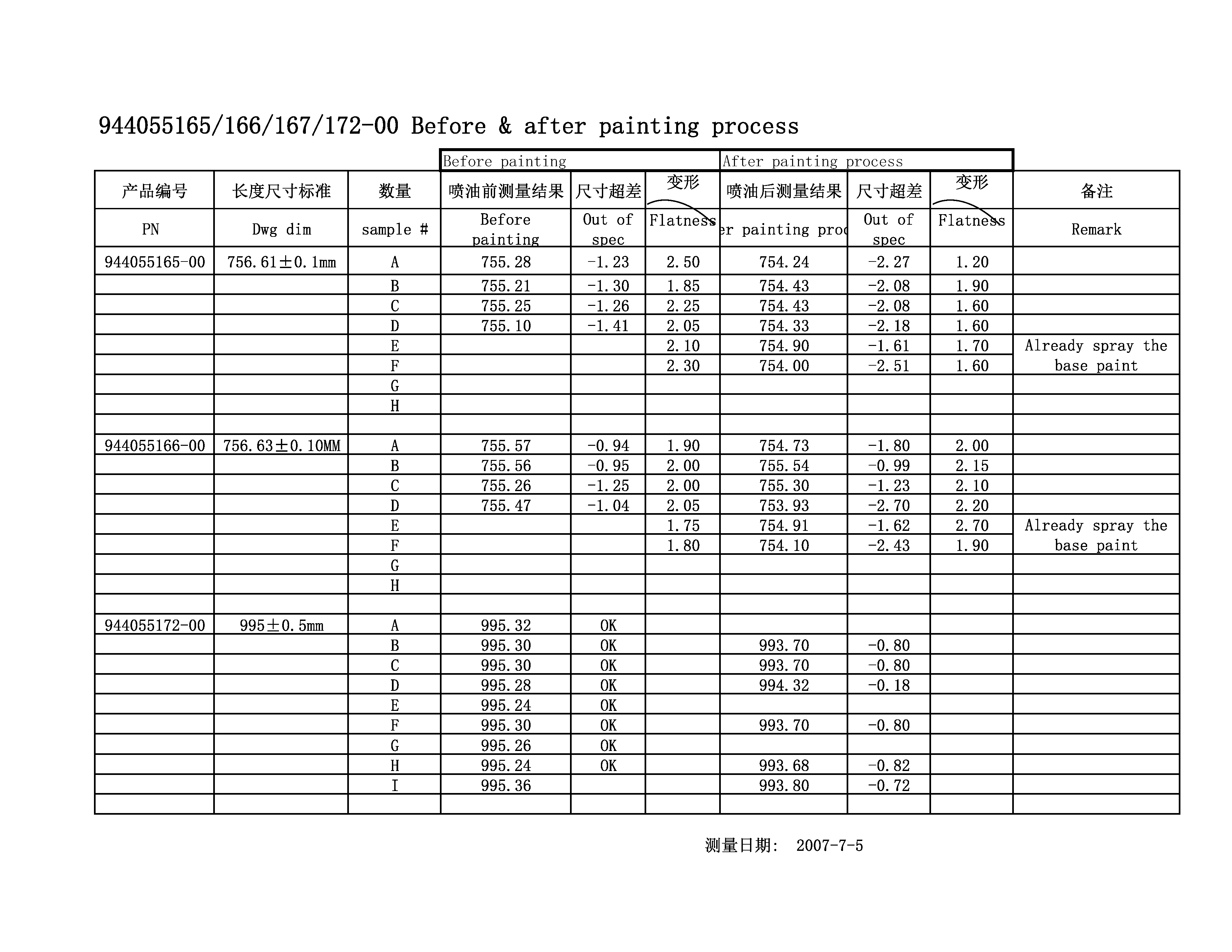

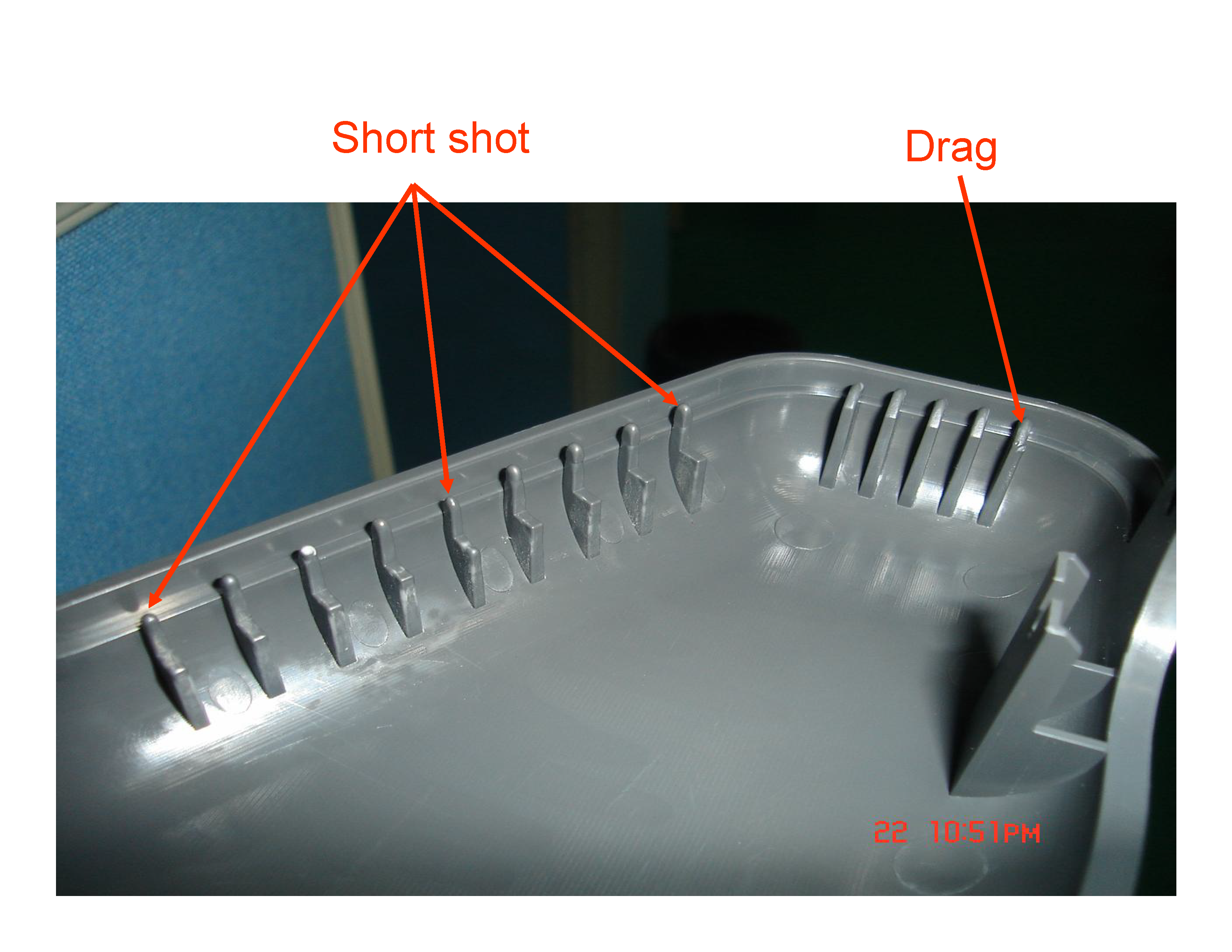

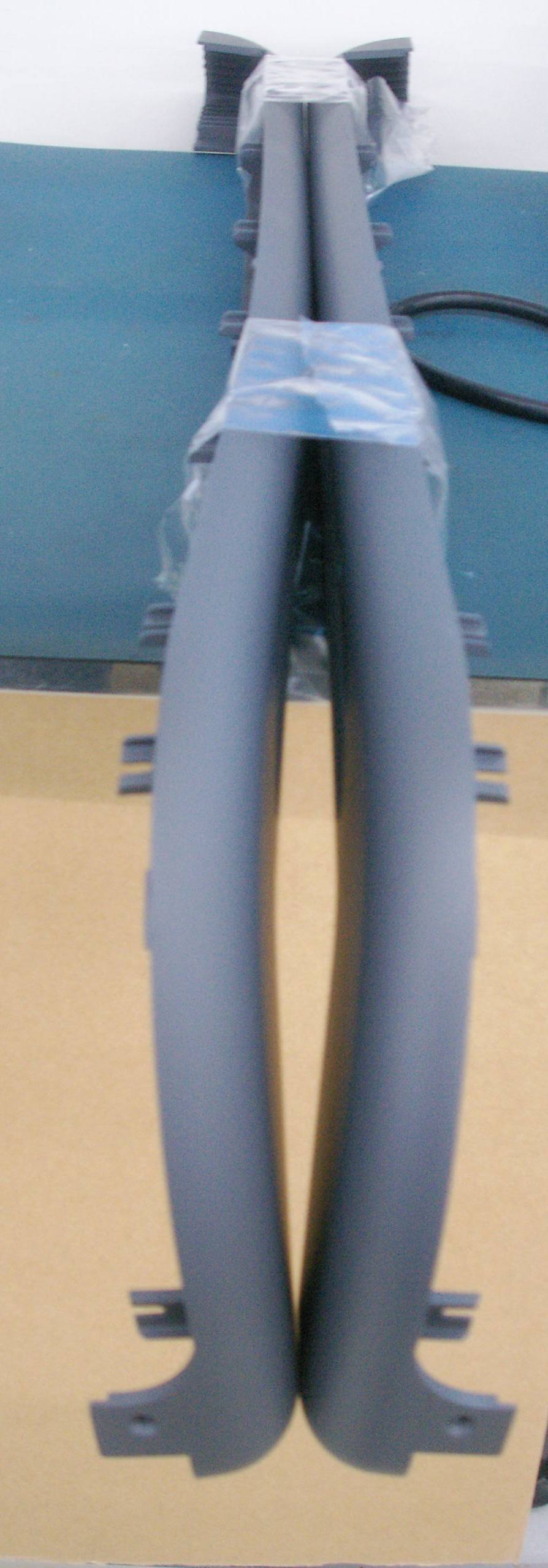

- Trigger: During Pilot, the primary ABS Side Caps (P/N 9440-55165/166) arrived with catastrophic geometric distortion: up to 2.50 mm of “banana” warping and 2.27 mm of linear shrinkage. The defect traced to the high-temperature “Rubberized Soft Paint” cure cycle — the vendor baked the long, heavy parts flat on wire racks (“Method C”), letting gravity sag the plastic through its glass-transition phase.

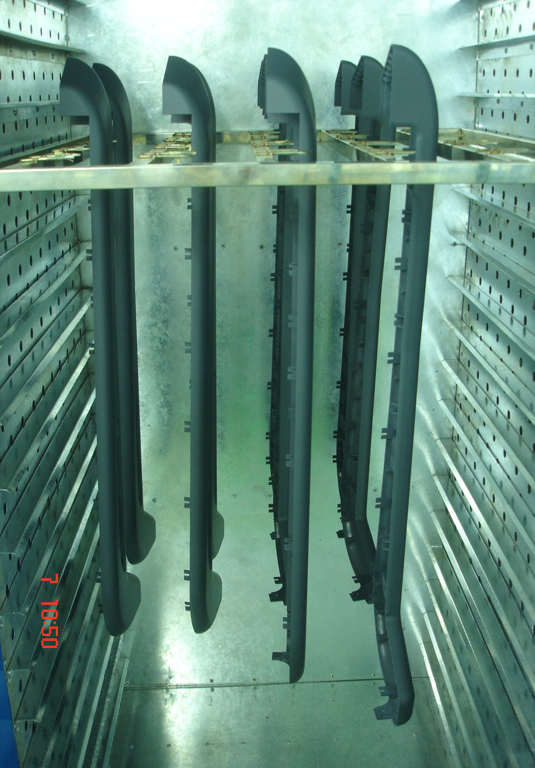

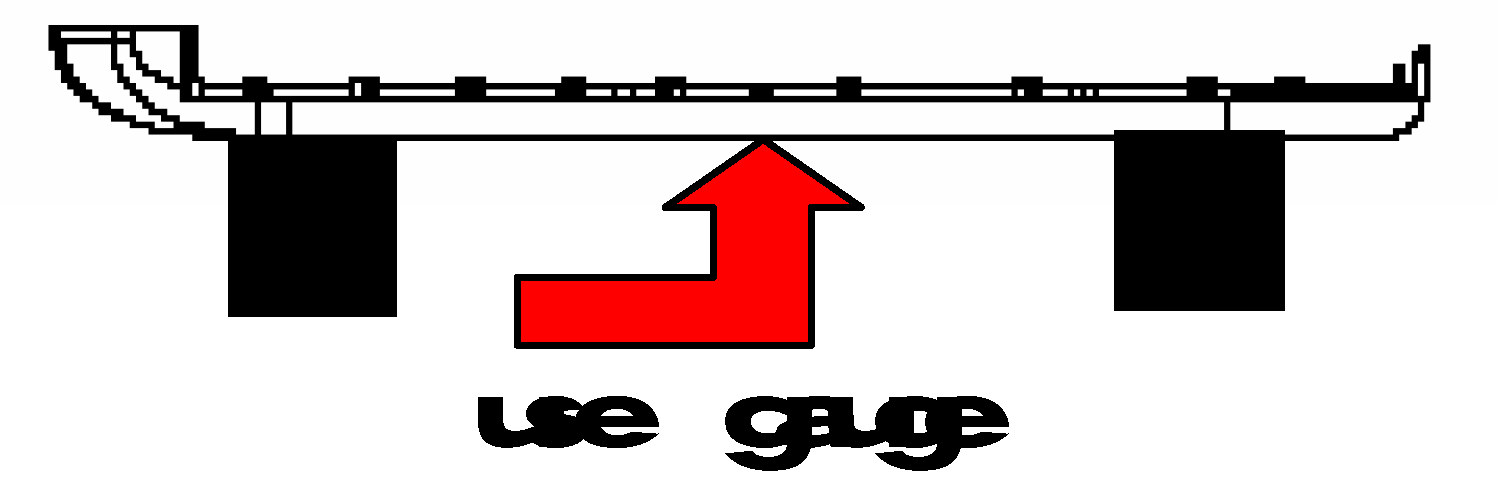

- Intervention: Rejected the vendor’s support-block proposal (“Method B”) and ran a comparative study instead. Engineered “Method A” — a Vertical Hanging Fixture that suspends parts during cure so gravity straightens them during cool-down. Codified the process via ECO 12740 as a permanent manufacturing specification for large ABS parts.
- Result: Reduced flatness deviation from 2.50 mm to below 0.50 mm, salvaging 100% of Pilot cosmetic yield with no new tooling spend.

2. Supply Chain Crisis: The Top Panel “No-Bid” Shock

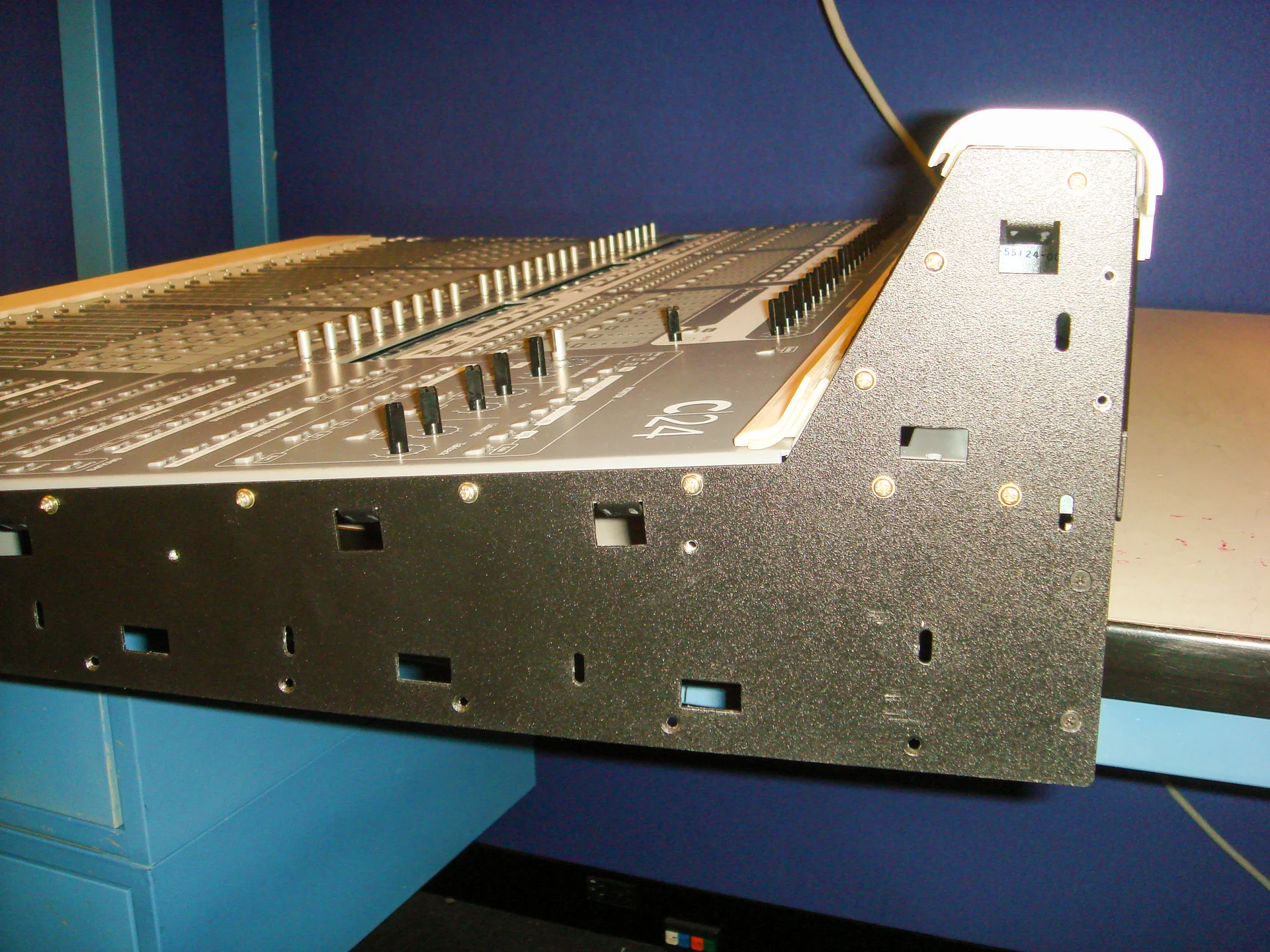

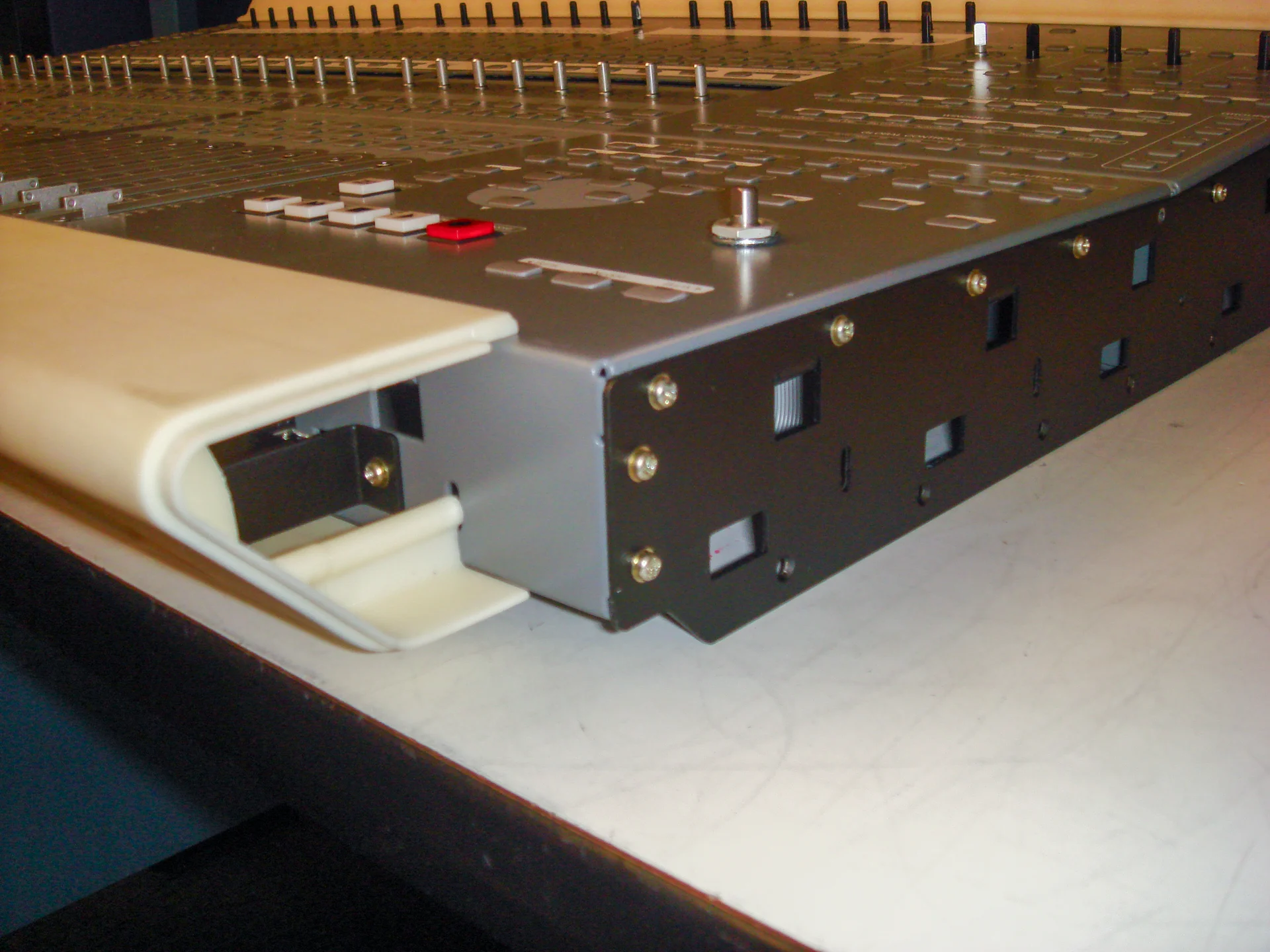

- Trigger: Mid-schedule, the primary overseas vendor (Kwanta/VTech) formally no-bid the console’s most complex part — the Top Panel (P/N 9420-55105). Its extreme density of welded standoffs physically blocked the vendor’s automated CNC welding heads, threatening a line-down scenario.
- Intervention: Executed a dual-source bridge strategy: engaged domestic vendor Mass Precision for rapid-turn manual offset-welded prototypes (reworking missing countersinks by hand to keep the line moving) while qualifying a manual offset-welding process at the overseas secondary vendor to bridge the schedule until automation retooled.
- Result: Unblocked the Pilot build and transitioned cleanly from domestic manual parts to overseas automated lines, protecting the November 20, 2007 First Customer Ship date.
3. Architecture Crisis: The EMI/Thermal “Rake”

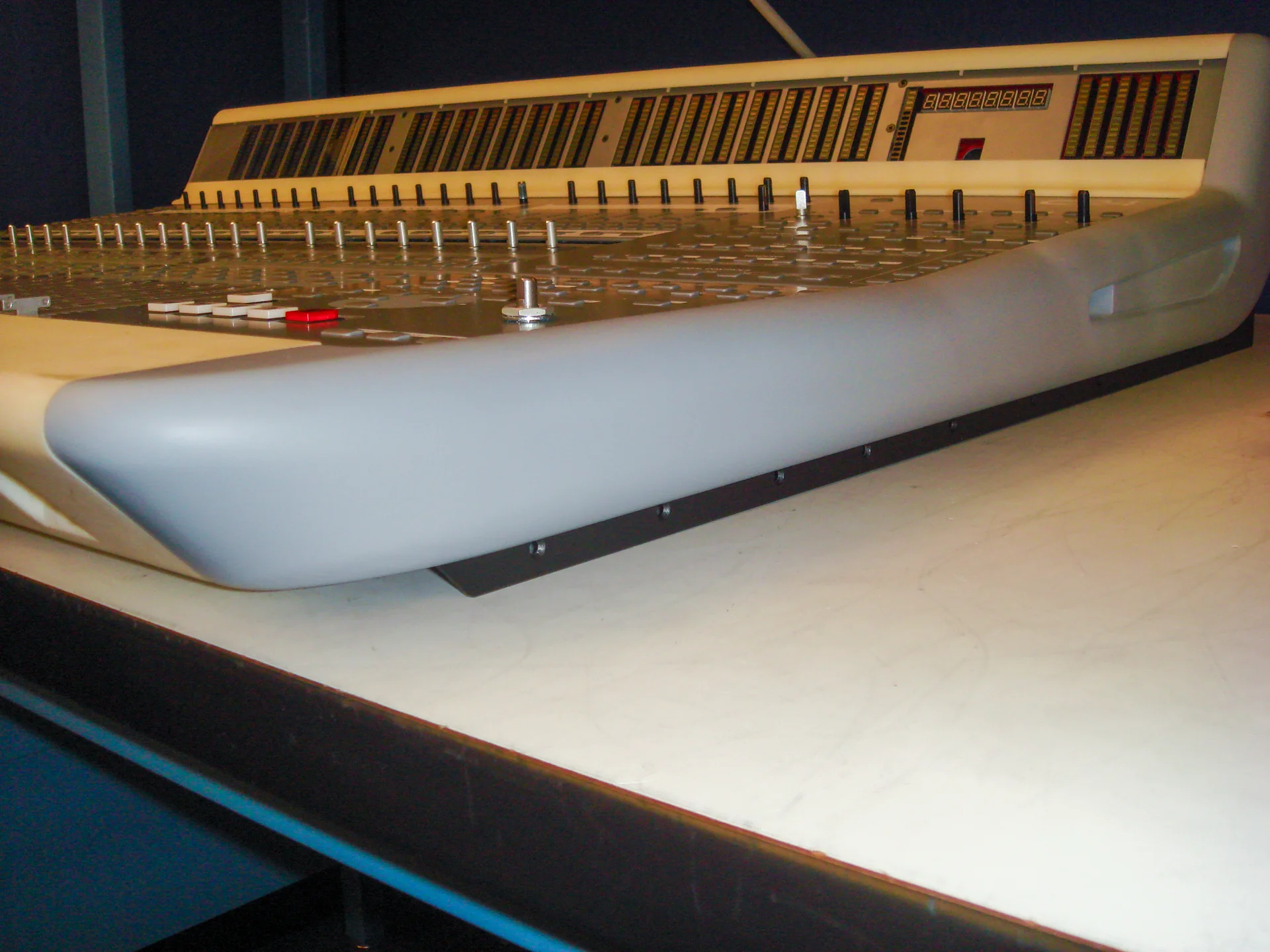

- Trigger: The initial 4U chassis stacked the power supply directly under the A/D converters, producing catastrophic EMI noise; the follow-up 3U crossflow layout then failed thermal qualification with air filters installed.

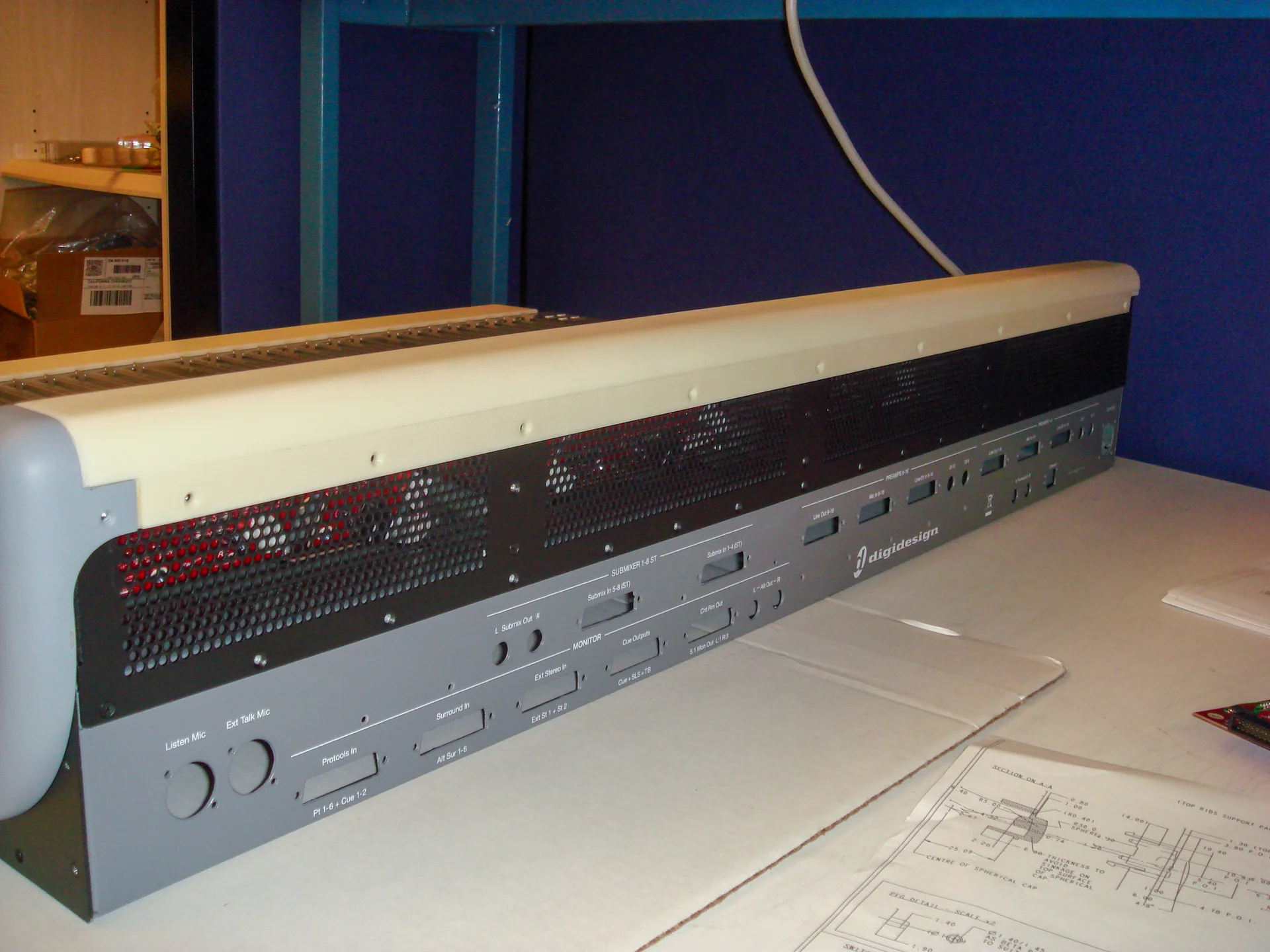

- Intervention: Redesigned the chassis around a revised 3U alignment with modified PSUs, metal connectors, and shielded cables.

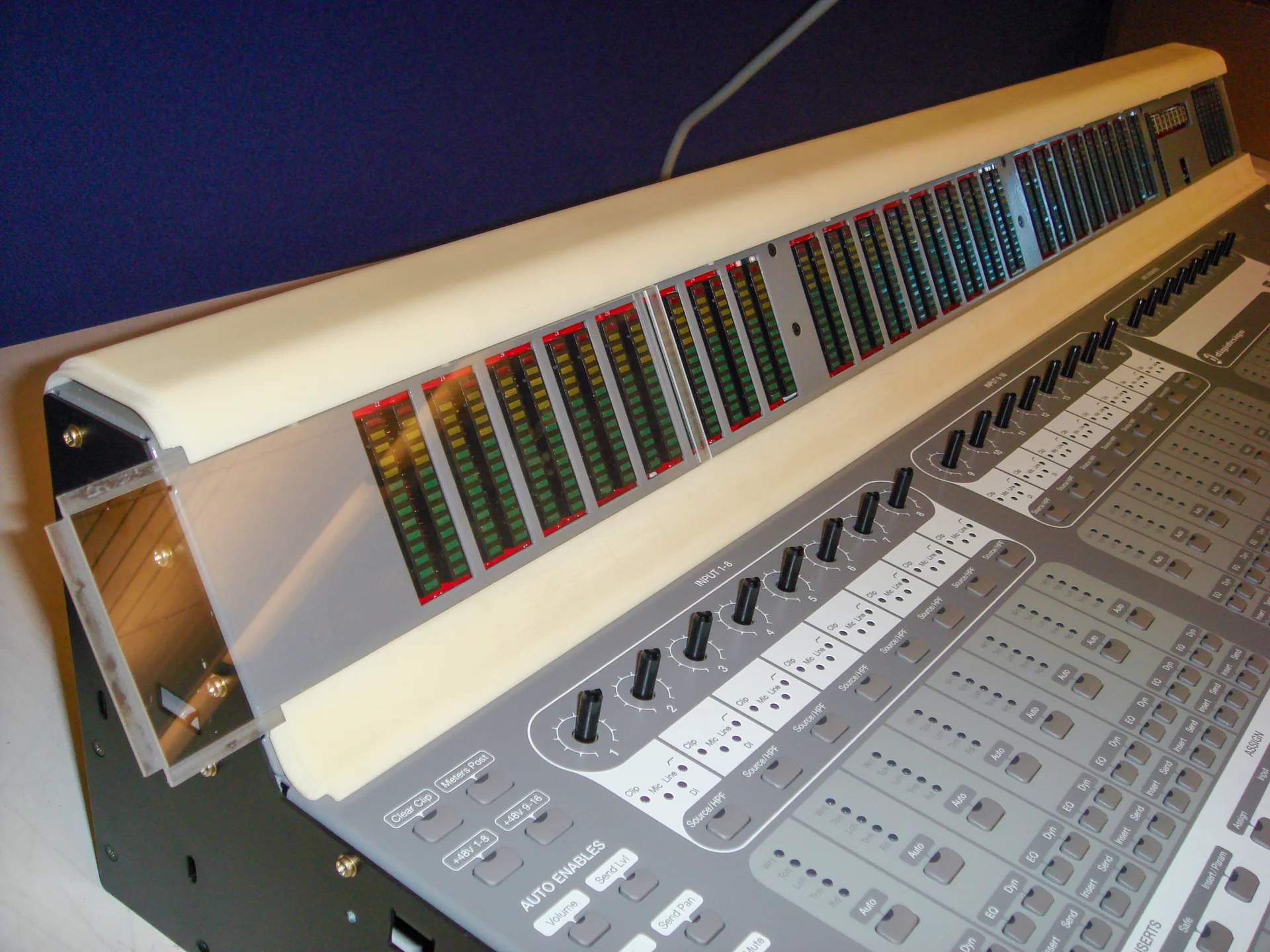

- Result: Neutralized the EMI path while passing thermal qualification — the packaging architecture that shipped.

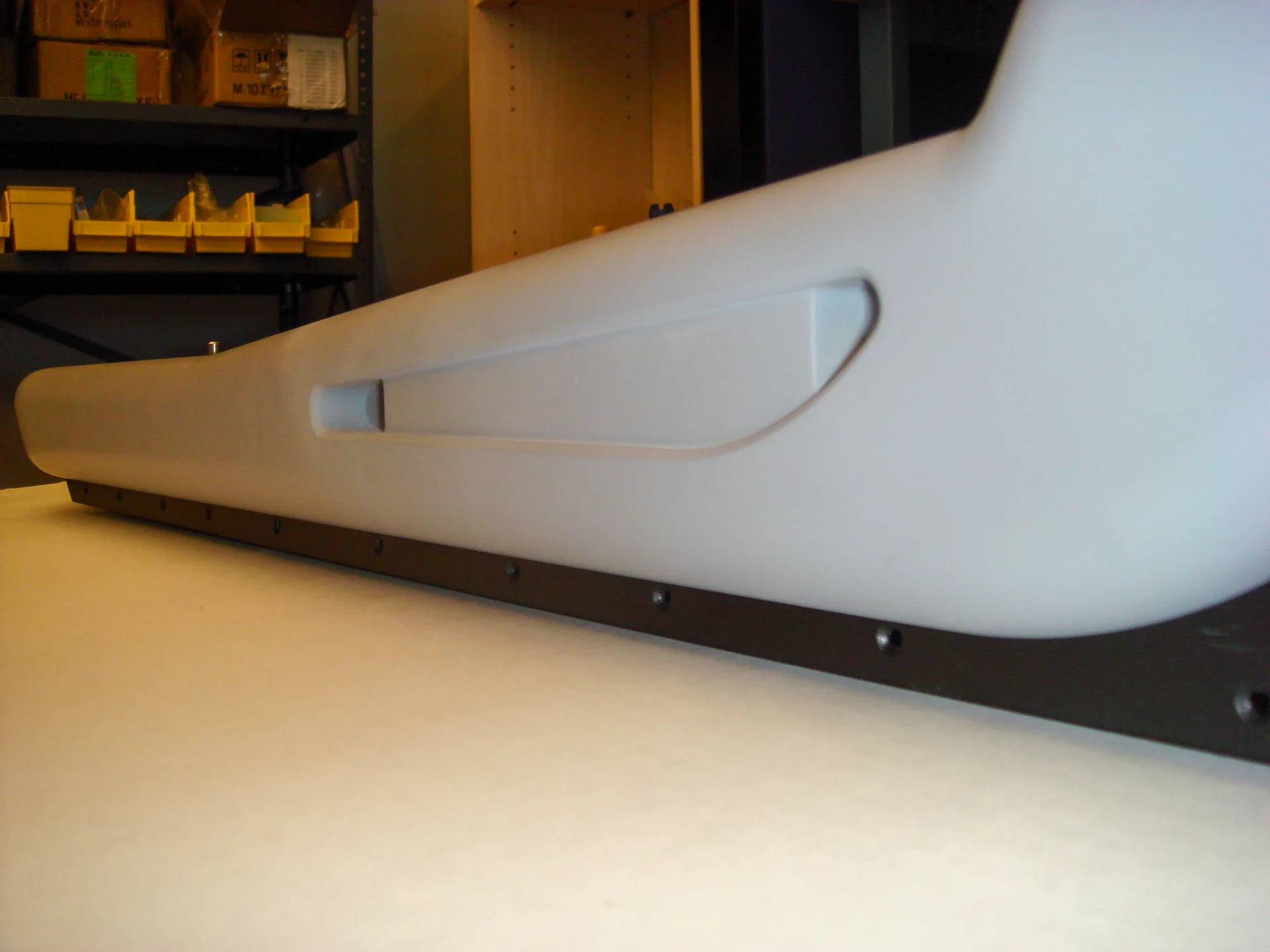

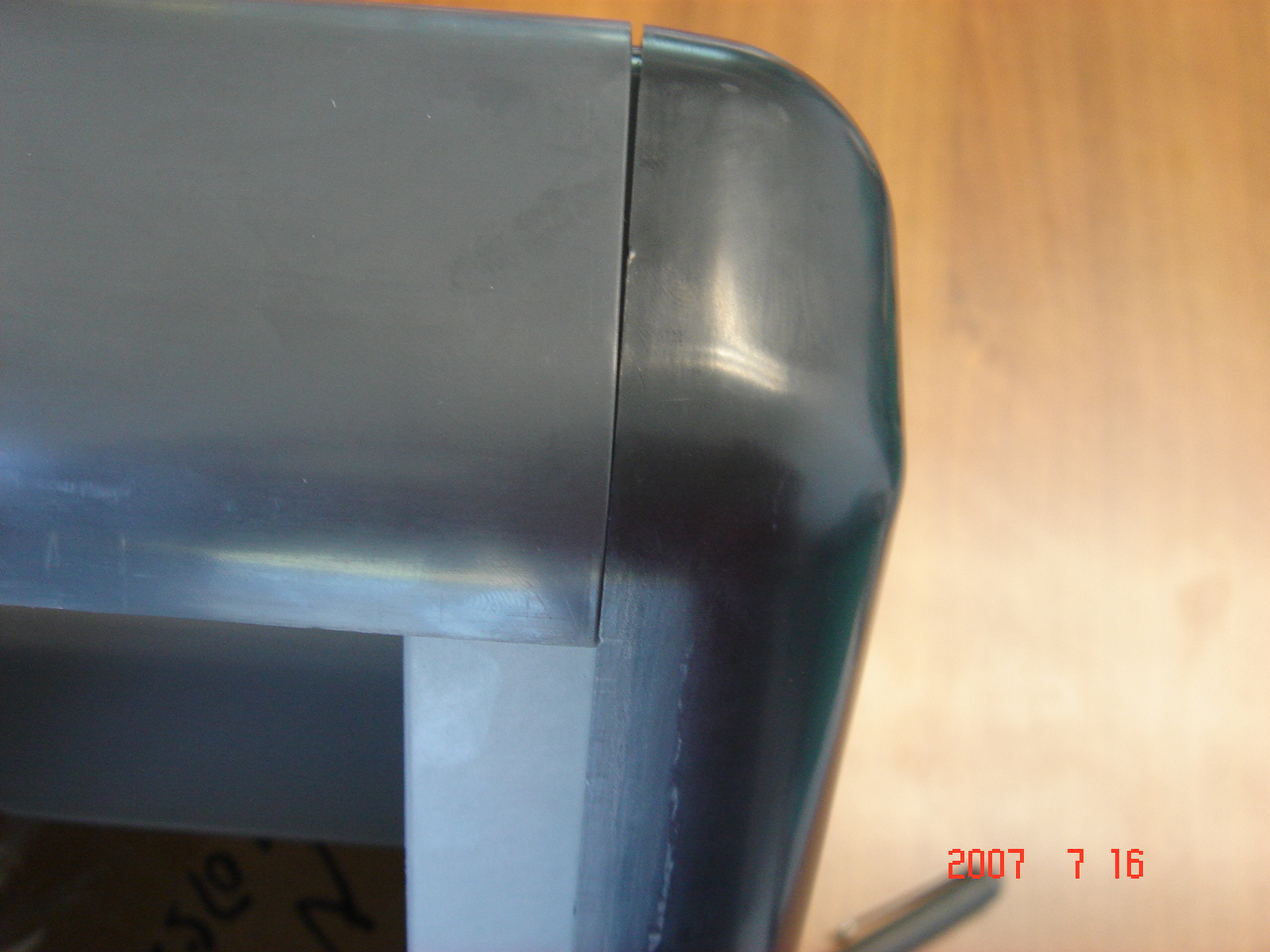

4. Serviceability Crisis: The Headphone Jack Fire Drill
- Trigger: Just before final release, service data showed the legacy headphone jack carried a 4.8% field failure rate — and the flush-mount design buried it behind the front bolster, making a simple repair a 2-hour chassis teardown.

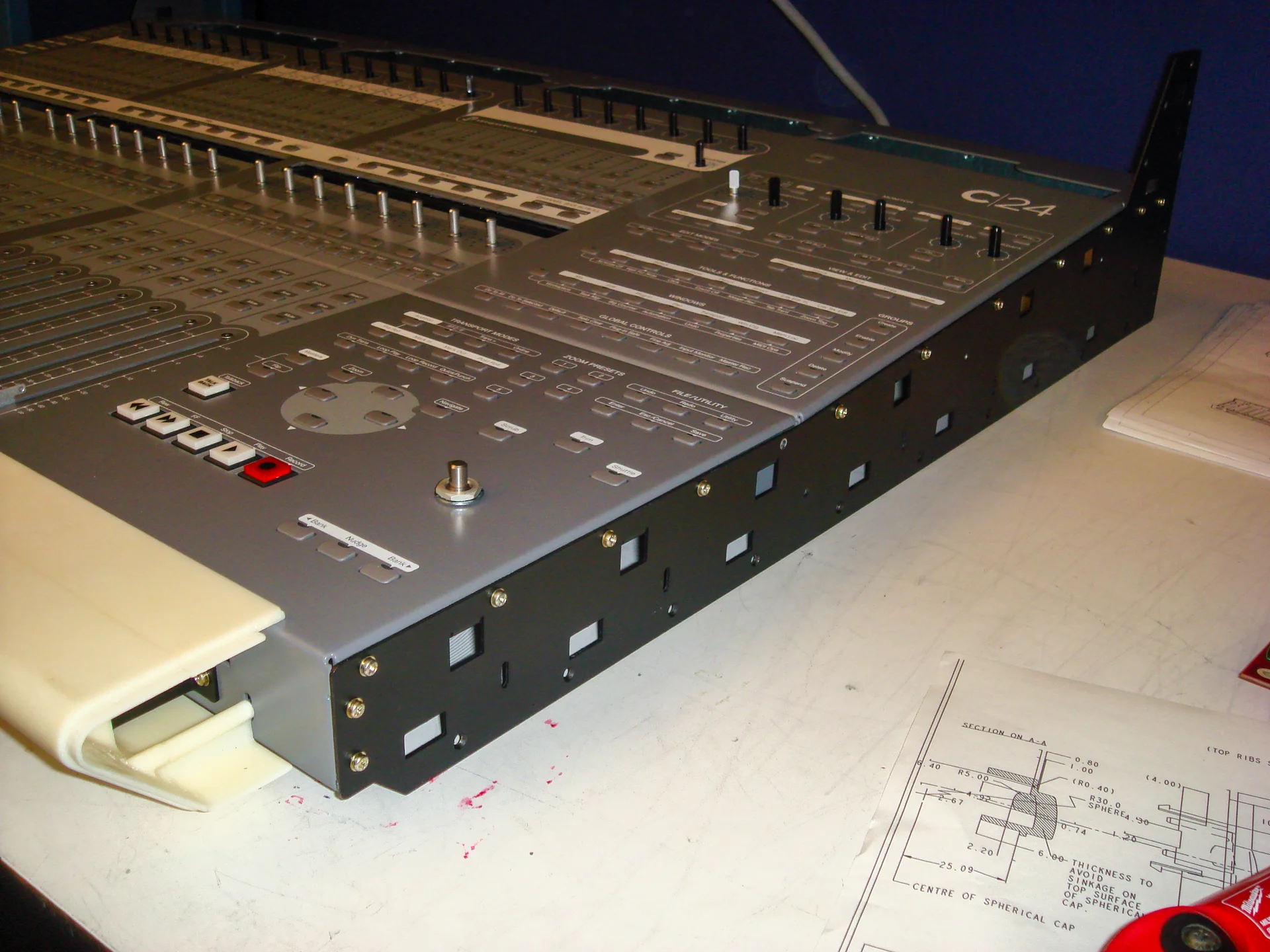

- Intervention: Executed an emergency redesign past the “Tooling Control Off” milestone: modified the Headphone Bracket (9420-55126-00) and Front Bolster (9440-55167-00) to create a recessed “trap door” clearance geometry (ECO 12993).
- Result: Converted a return-to-factory liability into a Field Replaceable Unit — Mean Time To Repair cut from over 2 hours to under 10 minutes via a single nut accessible from the bottom pan.
5. Integration Crisis: The Geometric Firewall

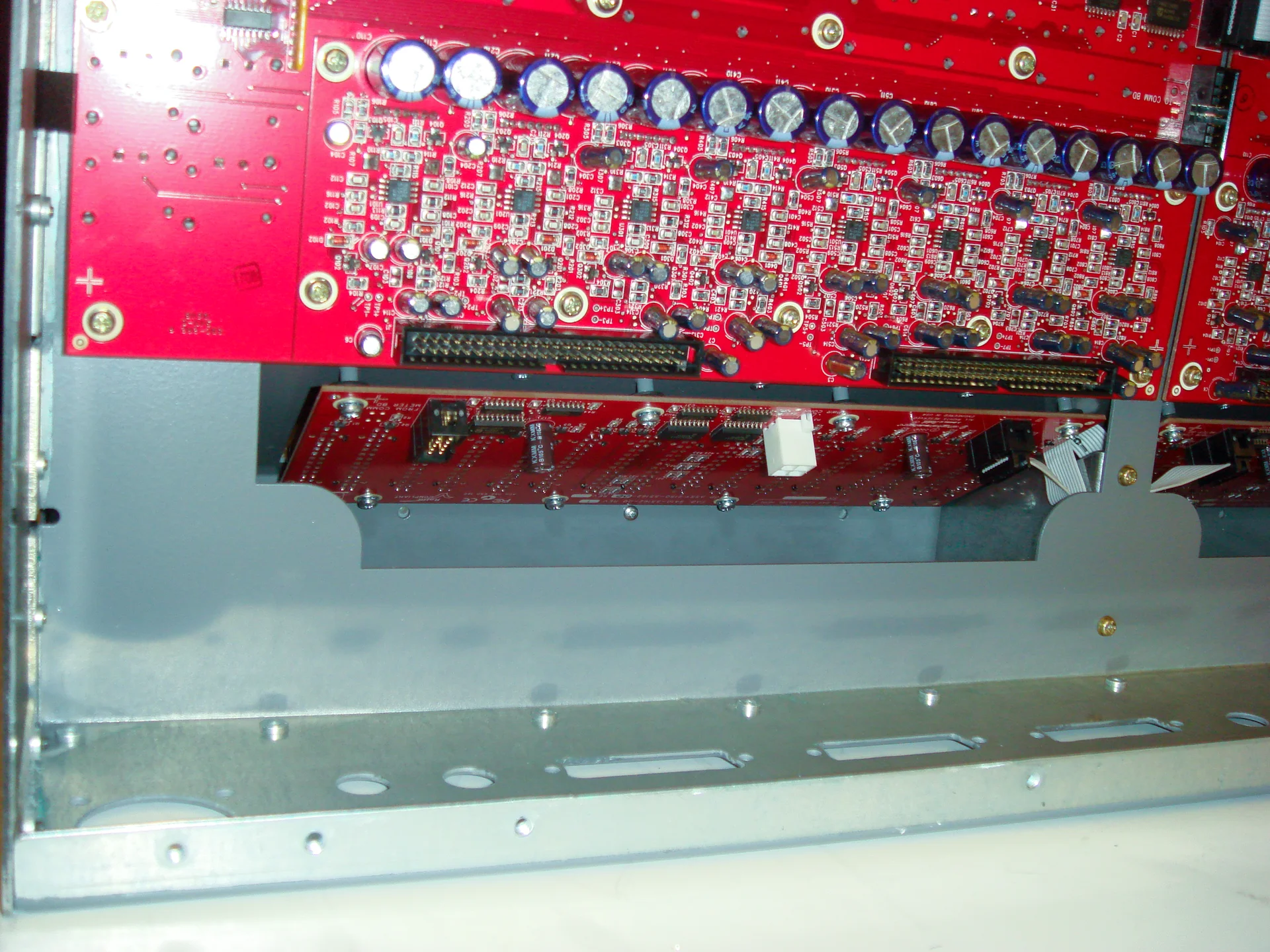

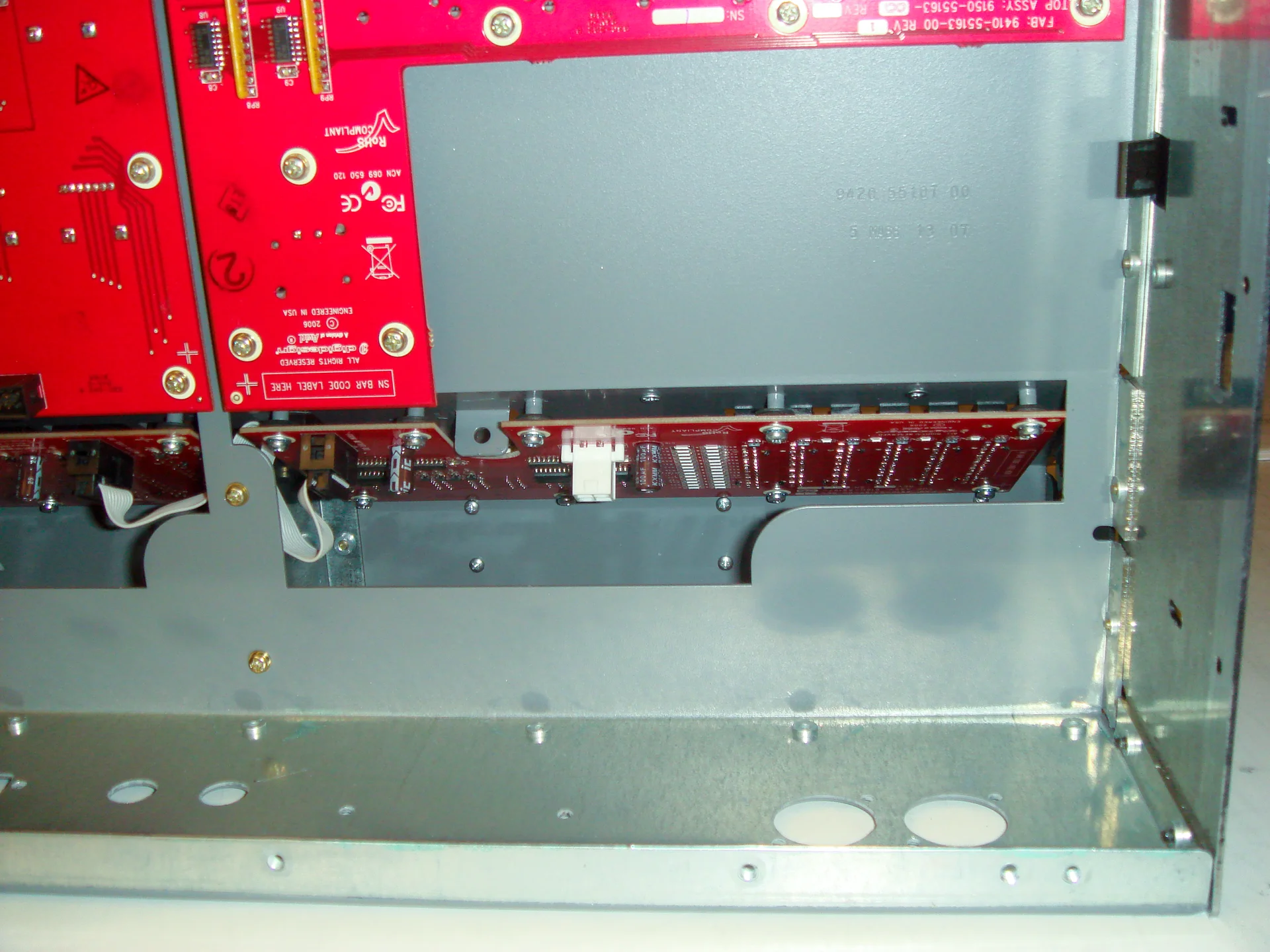

- Trigger: Integrating 19 distinct PCB assemblies into a low-profile chassis was being undermined by “wild west” file swapping — layout designers independently moving mounting holes and vertical components, guaranteeing downstream collisions. The MicPre 8 I/O vertical power connectors crashed into the bottom pan; SubMix headers landed in zones factory workers could not reach.

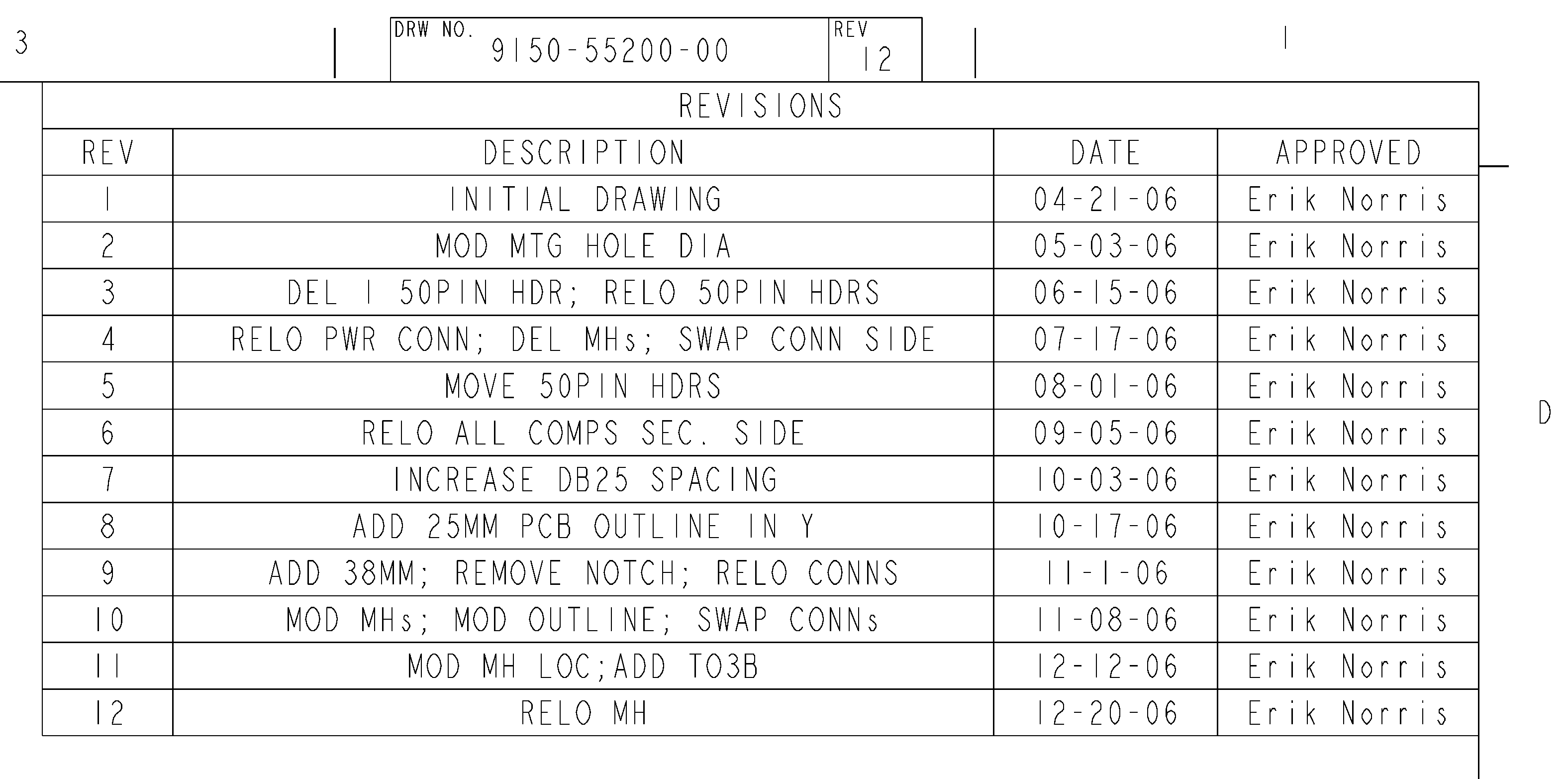

- Intervention: Authored and enforced the Data Control Drawing (DCD) Protocol: 50+ binding geometric contracts defining PCB outlines, 0.130” mounting holes, and Z-height keep-out zones. Submitted layouts were overlaid against the 3D master assembly and rejected on a 0.5 mm variance. The MicPre 8 DCD alone ran to Rev 12.
- Result: 100% mechanical fit on the first physical build, decoupling the mechanical tooling schedule from electrical layout iteration.
6. Regulatory Crisis: The Stranded PSU
- Trigger: The external Skynet power supply failed EMC prescans and suffered three catastrophic load failures at 230V/50Hz; tooling delays then stranded finished consoles waiting on UL certification.
- Intervention: Negotiated a simultaneous-certification protocol with UL to test the console surface without the finalized PSU, and orchestrated a hand-pack operation at the Menlo Park facility to manually apply UL labels to the first 100 units.
- Result: Protected the First Customer Ship date and Q4 revenue without regulatory exposure.
7. Component & Geometry Battles

- Bourns EM14 jog wheel: The cost-down 14 mm encoder arrived as raw samples with six exposed 0.42 mm wire leads — a soldering-defect factory. Enforced a pre-terminated harness specification (plug-and-play assembly) and engineered a custom surround with tolerance analysis that preserved the premium “scrub” feel of a $10k console on commodity parts (integration bracket via ECO 13082).

- The “Gill” surfaces: The signature side gills’ complex curves broke vendor CAD imports. Rebuilt the Class-A transitions manually in Pro/Engineer (16.5 hours) and exported geometry in bite-sized STEP chunks the toolmaker could digest — a modeling failure turned seamless assembly.
- The “Kenny” cosmetics war: The secondary metal vendor shipped panels with ripples, dents, and “dental white” silkscreen that washed out against the grey chassis. Enforced a First Article Inspection regimen, forced ink recalibration to true Bright White, and documented bend-line defects photo-by-photo until the vendor upgraded its tooling.
III. Governance & Rhythm
- The Pulse: Managed under a constant “At Risk/Replan” status from an initial Q1 2007 target to the November 2007 ship, with weekly War Room coordination across Silicon Valley and Guangdong. The mechanical architecture was a solo mandate: one engineer integrating 19 PCB assemblies and 15 sheet metal parts inside extreme geometric constraints.
- The Artifacts:
- DCD Protocol — the geometric firewall; 50+ binding drawings, MicPre 8 at Rev 12.
- General Modeling Guide — authored to hold data integrity through the Pro/Intralink 8.0 server migration.

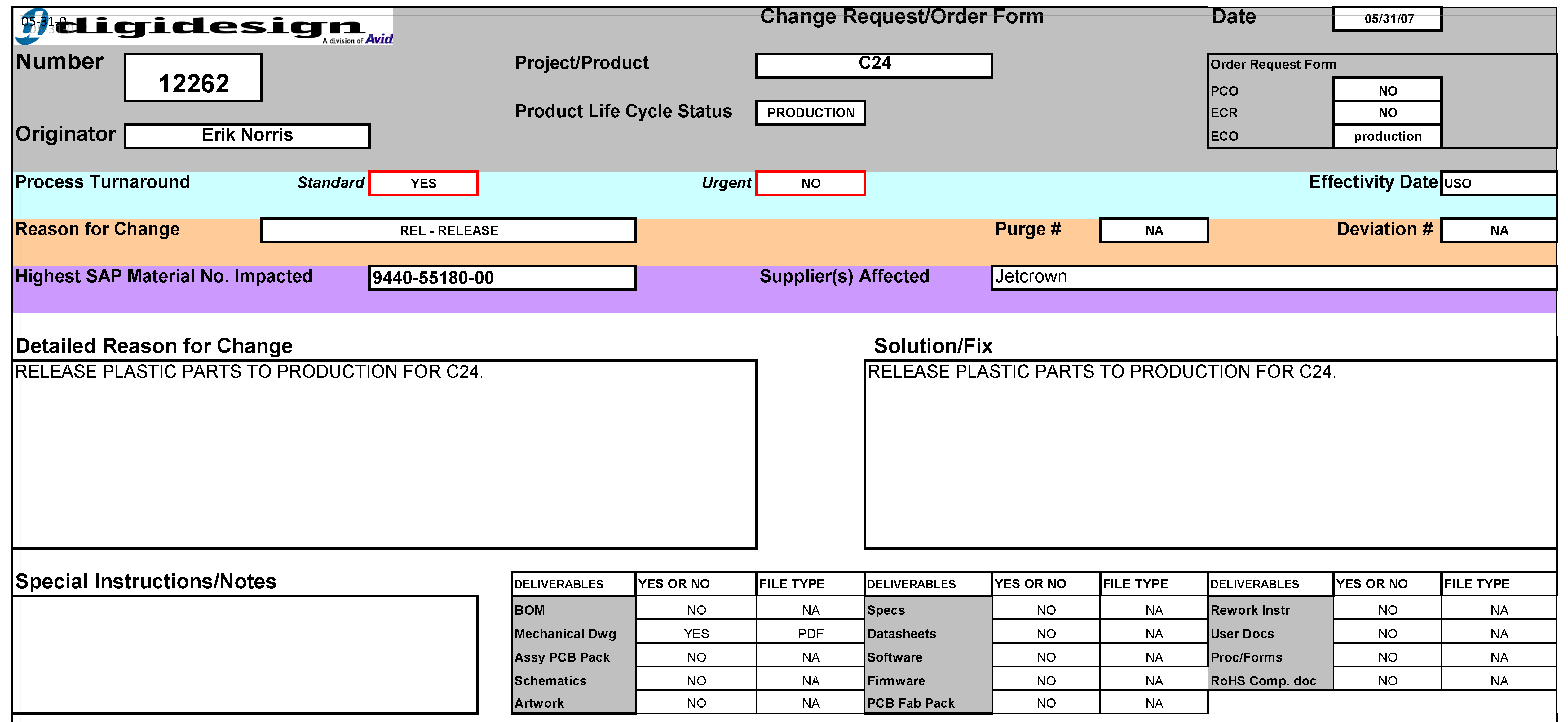

- ECO 12740 — vertical-hang cure fixture, released as a permanent process specification.

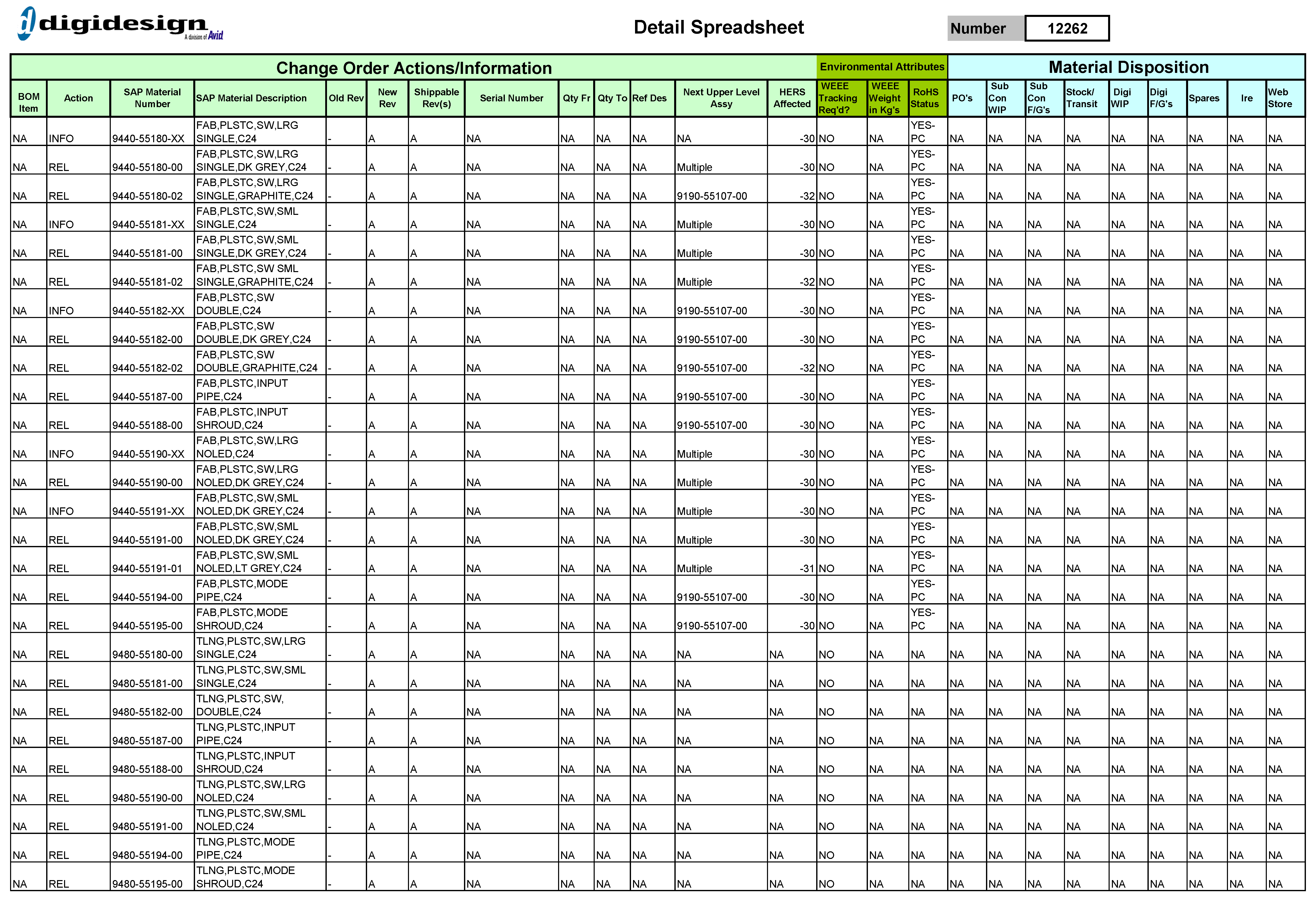

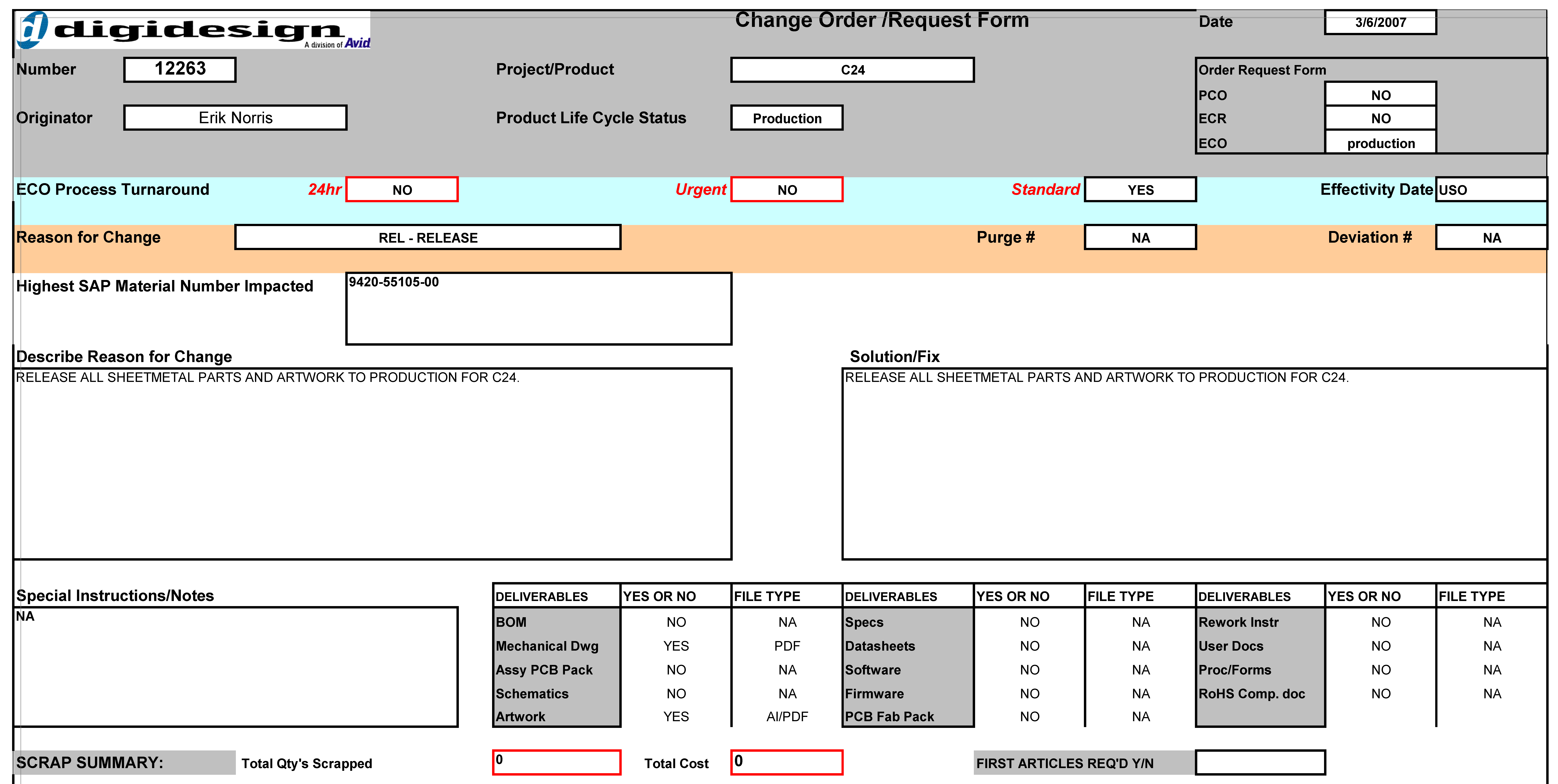

- ECO 12263 — urgent “release all” of sheet metal and artwork to salvage the schedule.
- ECO 12993 — headphone-jack trap-door serviceability redesign.
- ECO 13082 — Bourns jog wheel integration bracket (P/N 9420-56156-00).

- ECO 13707 — re-dimensioned drawings with hardened tolerances to lock inspection criteria.
IV. Quantified Impact
- Delivered 500 units for Q4 2007 FQA and revenue recognition through a binary line-down supply crisis.
- Eliminated the ~$200/unit licensing royalty by re-architecting the chassis around 16 in-house pre-amps.
- Secured a 51.80% gross margin on a $9,995 MSRP despite a 20% annual rise in raw steel costs.
- Held the $9,995 MSRP globally by absorbing bridge tooling as a project expense rather than permanent COGS.
- Salvaged 100% of Pilot cosmetic yield by correcting 2.50 mm thermal warp to below 0.50 mm.
- Cut headphone-jack MTTR from over 2 hours to under 10 minutes with the trap-door FRU redesign.
- Achieved 100% mechanical fit on the first physical build of all 19 PCB assemblies.
- Enforced the geometric firewall with 50+ Data Control Drawings.
- Managed 13 major ECOs inside a compressed 6-month window to realign production tooling with design reality.
- Processed 100 units through the Menlo Park hand-pack to bypass the stranded-PSU certification block.
V. Source Trail
The claims above rest on the project’s primary evidence archive — engineering change orders, data control drawings, vendor inspection reports, and build photography — compiled through the NotebookLM forensic registry:
944055165-166-00 baking fixture chg.pdf— warped ABS parts on flat racks vs. the vertical hanging fixture.before_and_after_rubber_paint.pdf— inspection logs proving 2.27 mm paint-cure shrinkage.DCD_9150-55200-00_REV_12.pdf— the MicPre 8 geometric contract at its twelfth revision.China Sheet Metal.pdf— photographic record of rejected vendor panels (ripples, dents, washed-out silkscreen).C24_plastic_fit-misc.pdf— fit-check interference and PEM insert pull-out failures.fit-check-01.jpg/C24_first-shot_gap-check.pdf— gap analysis of plastic shrinkage against sheet metal.gill_dim.pdf— finalized dimensions for the rebuilt side-gill surfaces.bourns_em14.pdf— integration specification for the replacement jog wheel encoder.ECO_12263.pdf— the urgent sheet metal release that put production back on schedule.
